London East Phase 3 Development Update 5

With focus turning back to Phase 3 in Q4, following the completion of Phase 2 in Q3, we have some updates to relay as the build schedule for Data Halls 5 and 6 begins to gain traction again.

Development work continues to see a certain level of distribution across both the operational side of the facility, as well as the new expansion. Despite Phase 2 now being complete with the onlining of Data Hall 3, we had an additional works list for the active side of London East, which will see the improvement of various functions and features throughout the facility.

Let’s get straight to the updates for Phase 3:

Exterior

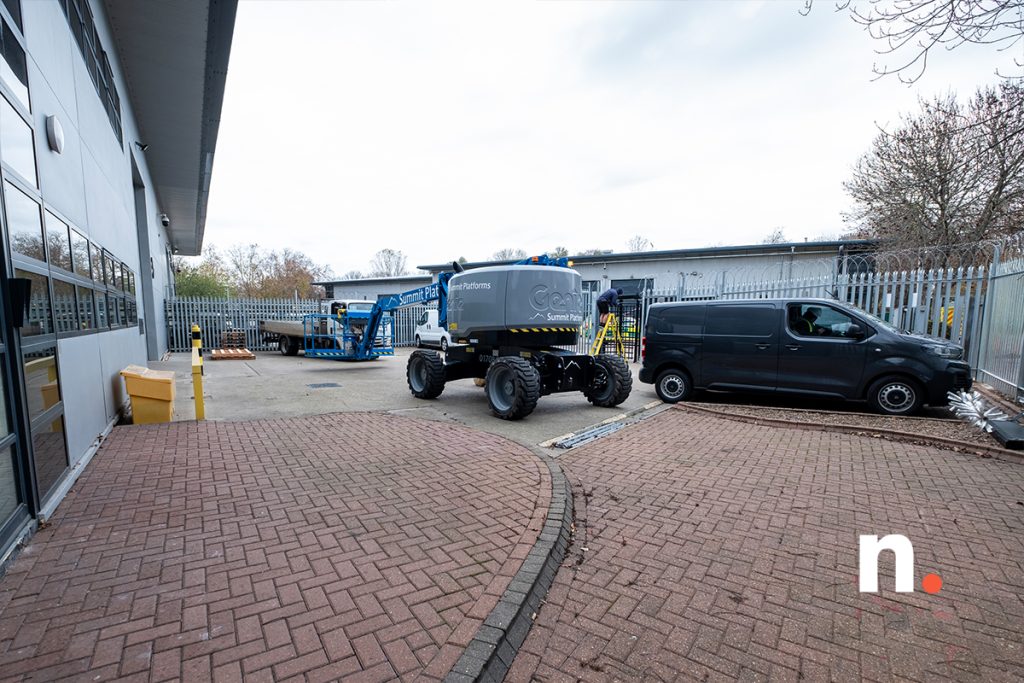

The new perimeter fencing and associated access routes have seen lots of progression since the end of the summer
Exterior

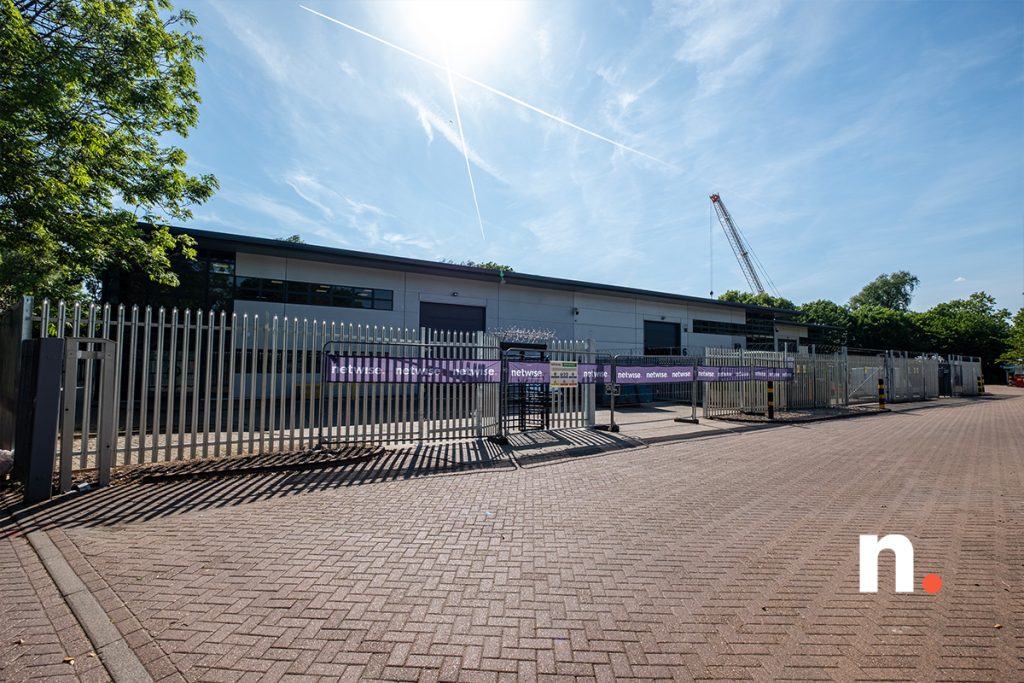

Here’s a wider contextual view of the new Unit 5 frontage, with the existing frontage of Unit 6 in view on the right hand side
Exterior
The view from the main east-side entrance to the Datapoint estate, looking across what is now the full extent of the London East facility footprint
Fencing

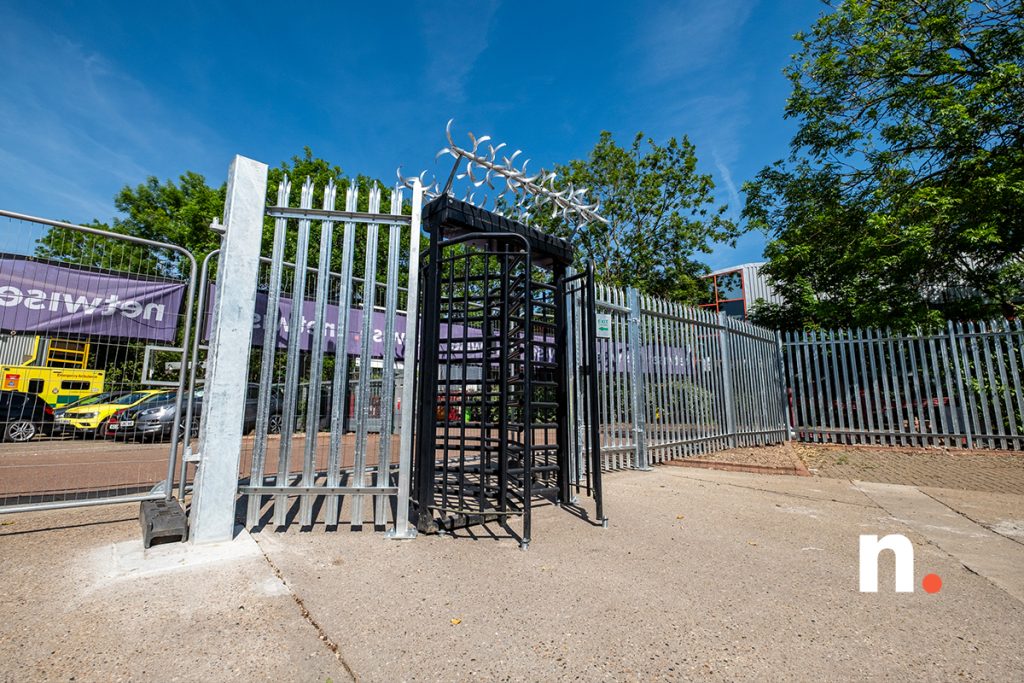

Here we see the turnstile installed for the first time, ahead of access control implementation in the new expansion space
Fencing
The new vehicle access gate opening is now ready for installation of the 5-metre folding gate itself

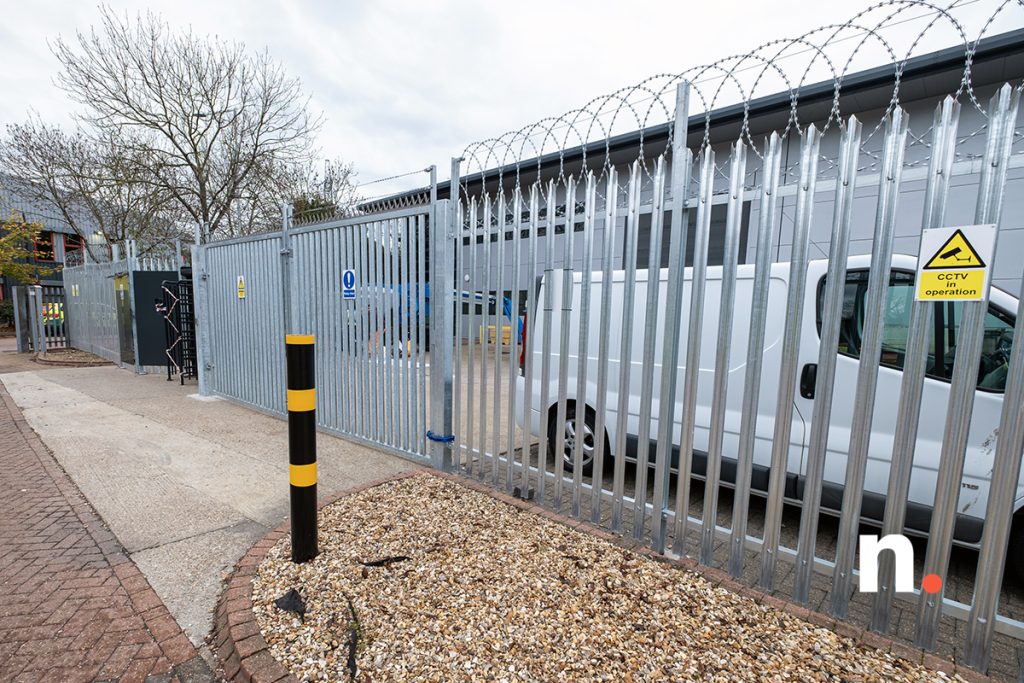

Entry U5
The new gate is now hung ahead of automation, and the full perimeter has had its razor wire fitted along the top to match that of the existing perimeter

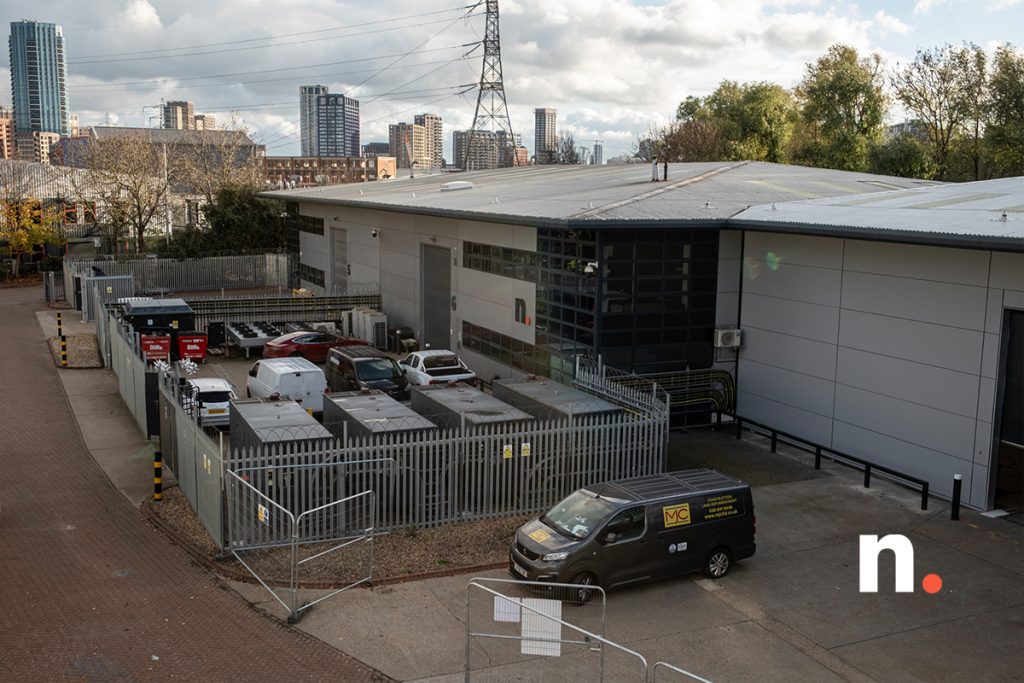

Exterior
This is the view of the new Unit 5 frontage from the main entrance of the Datapoint estate, following the completion of the perimeter (aside to full access control implementation)
Exterior
Access control integration is now well underway, which will enable the onlining of the main entry points to the new footprint, which all remain in a physical hard-locked state at this point – signage and panelling has now also seen completion in this area

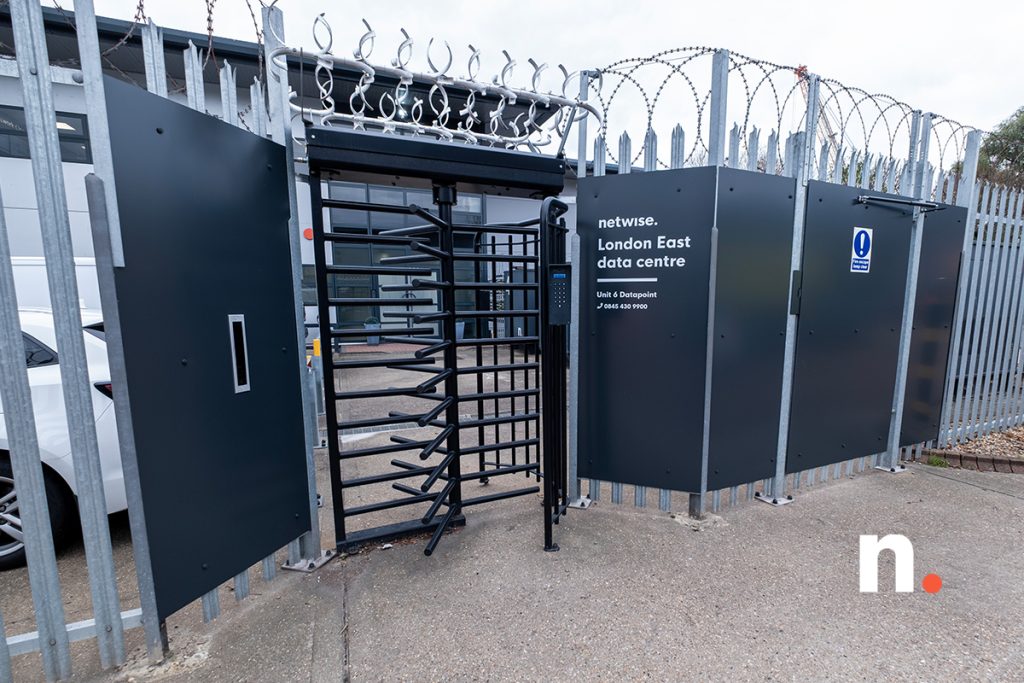

Exterior
As part of this same work-set, the client entrance to Unit 6 (which will remain the main client entrance after the expansion project is complete) has been fully refreshed, with new panels and signage, as well as a new small package drop box

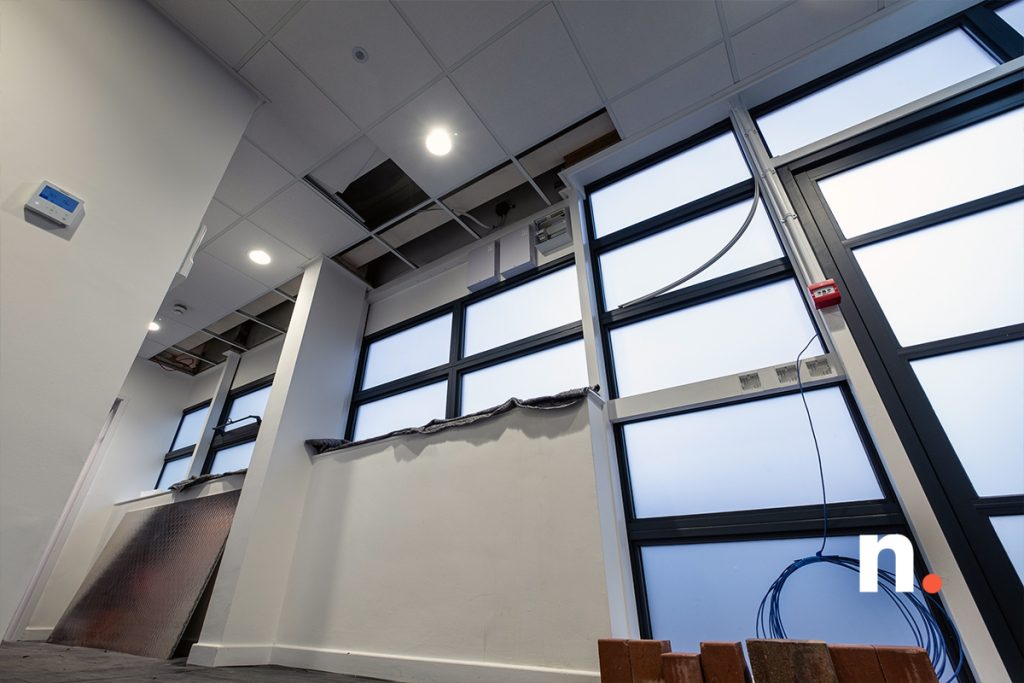

Access Control
The access control systems are being deployed in the front of the new footprint, which will ultimately control the entry and exit process on this side of the facility
Fencing
A side access gate has also been installed, which will securely isolate the new external plant area from the additional parking facilities in the front
Fencing
Here is a view of the side and rear perimeter as completed
Fencing
The new vehicle gate is centre-folding to accommodate different space constraints on this side of the facility, unlike the sliding gate deployed as part of the existing frontage
Exterior
Here is an elevated view of the main entrance to the new space, along with the fencing installation in this area – the new logo is on it’s way to us for installation soon
Exterior
Here we have an elevated view across the active centre of the London East facility, and onward to the new expansion project – the newly added Unit 7 is just visible on the right hand side
Unit 7
This elevated view shows the full extent of the London East footprint, following the successful integration of Unit 7 into Netwise control
Exterior
The addition of Unit 7 completes our footprint control strategy for the London East facility
Fencing
Work on the new expansion project continues across a wide range of areas, including work on the roof which requires specialist access equipment

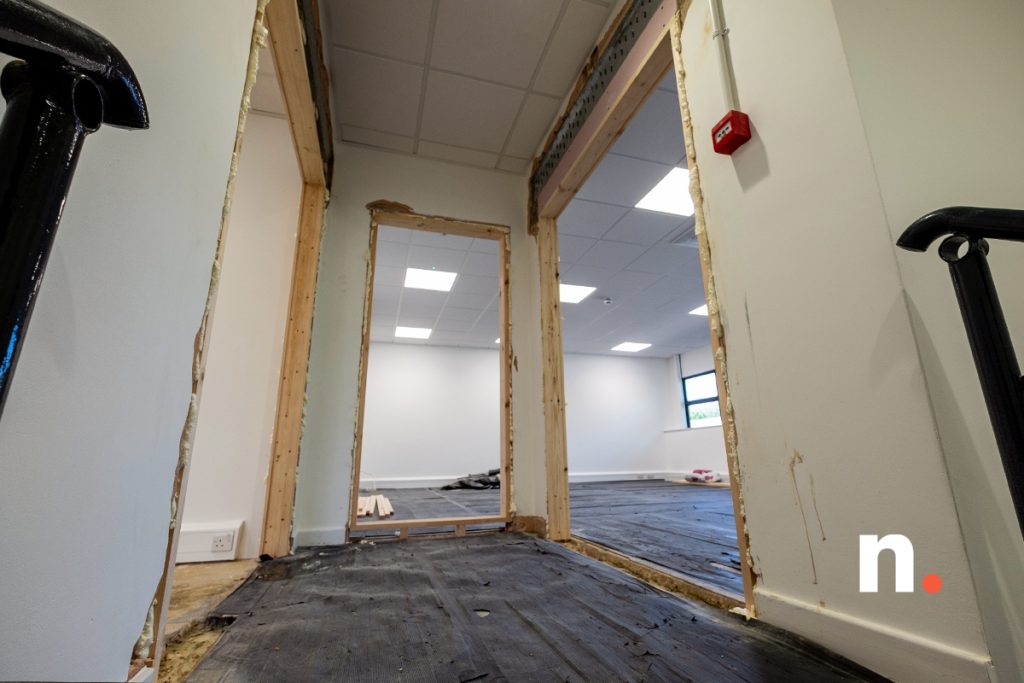

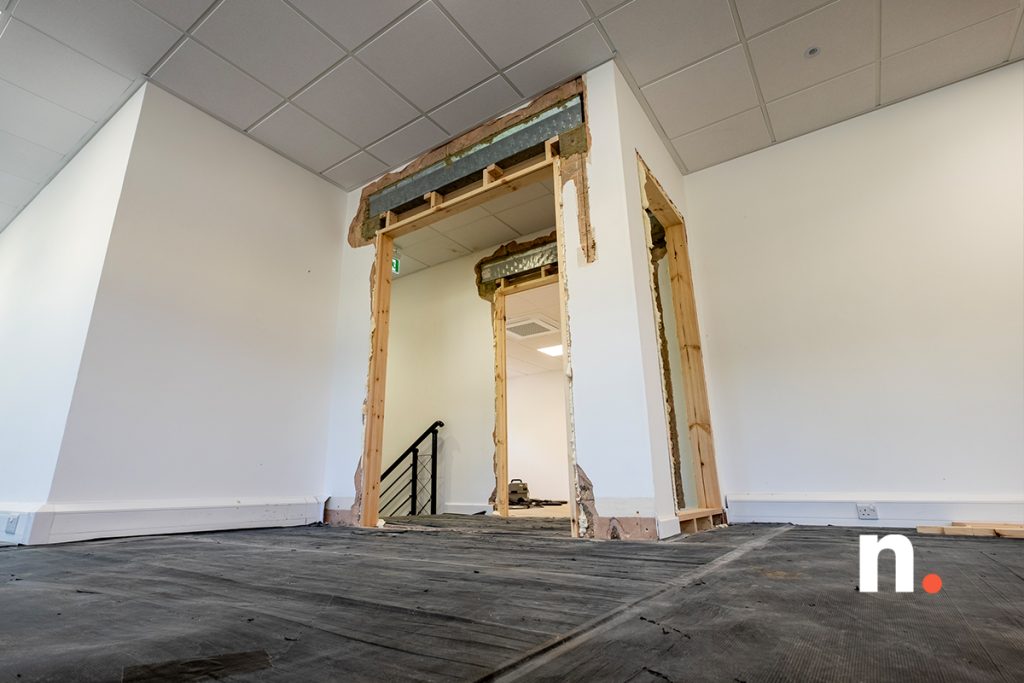

Door Openings

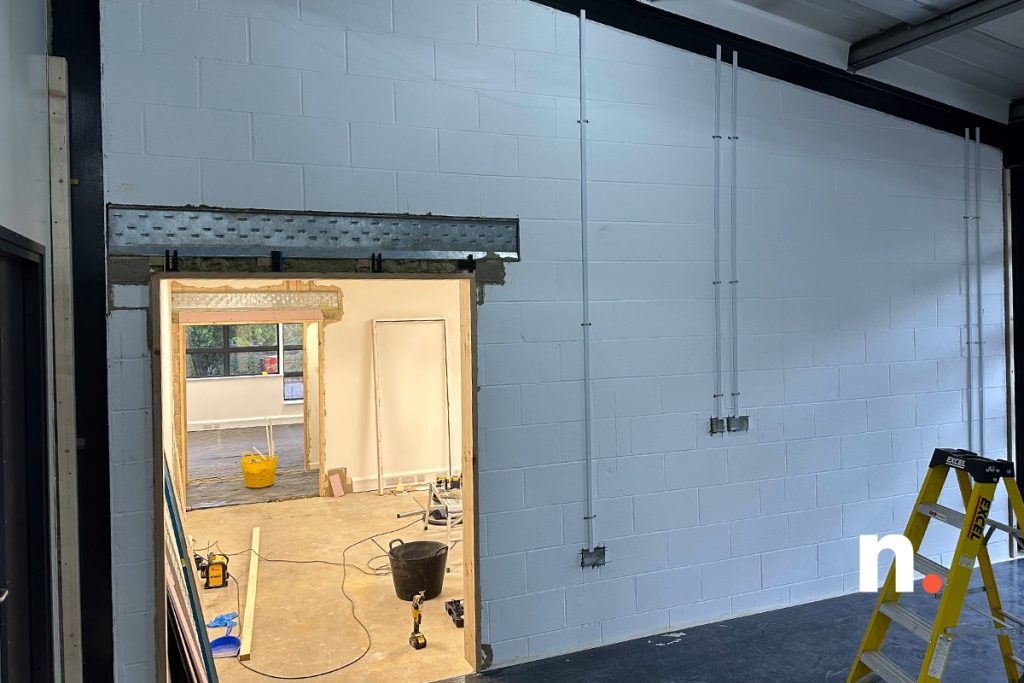

The new door openings across the facility have seen progression, but remain in a ‘roughed-in’ state in non-technical spaces
Door Openings

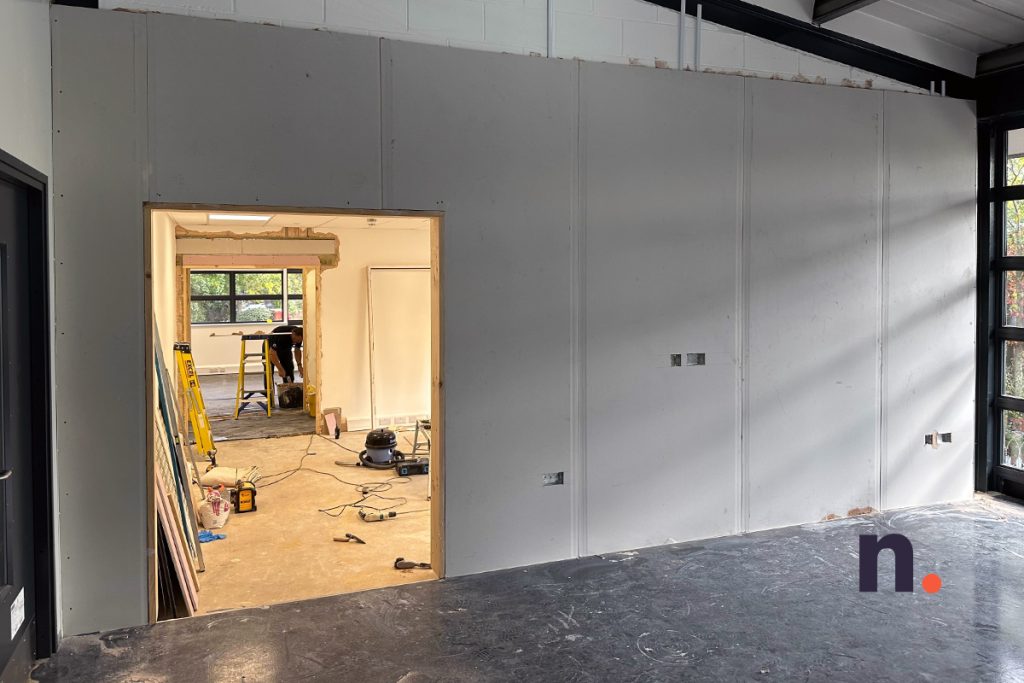

The new openings have been framed out head of repair work to refinish adjoining surfaces

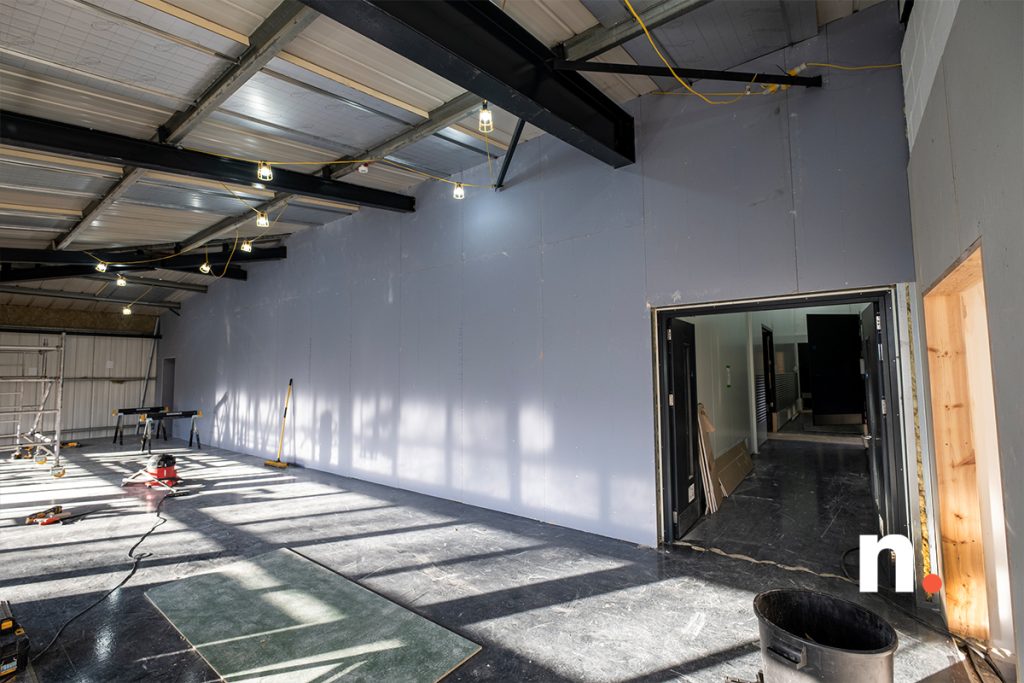

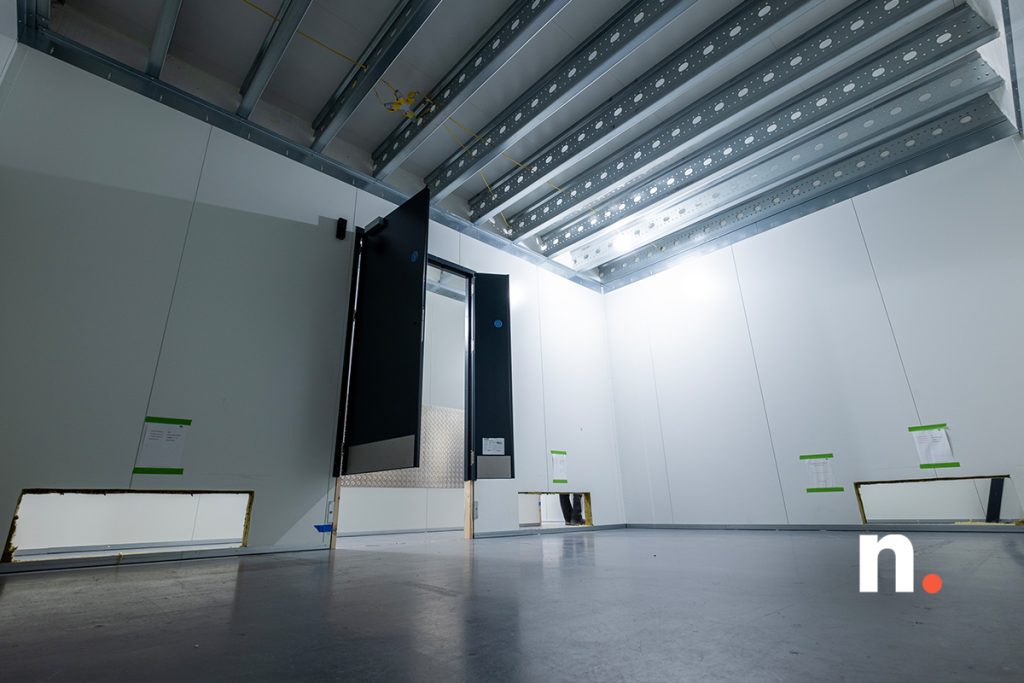

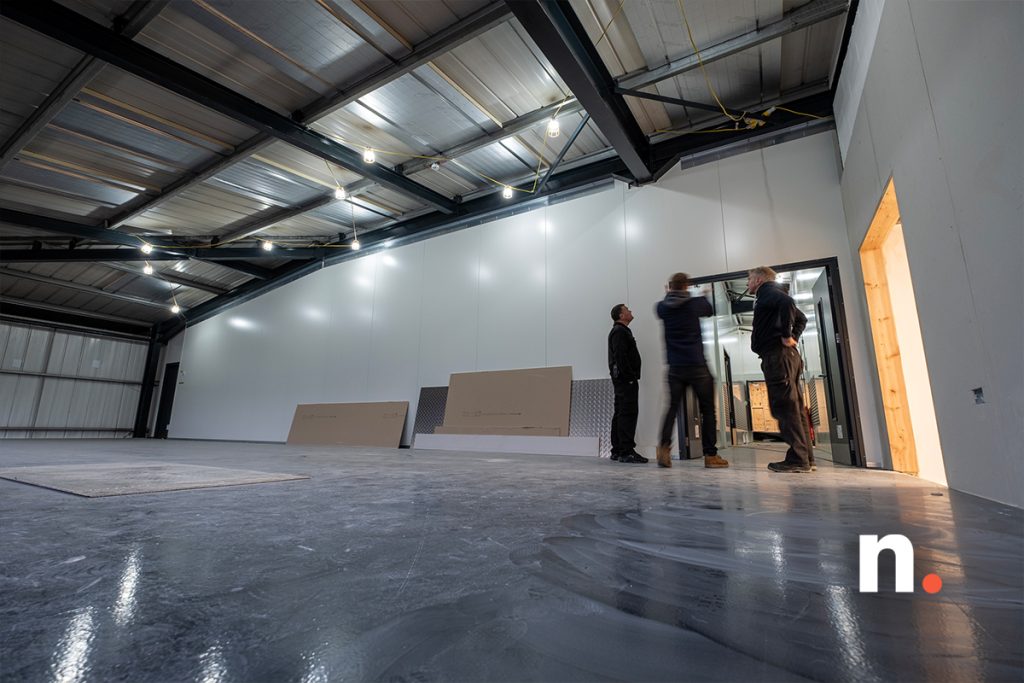

Walls
In the new office and meeting room area of the expansion footprint, first fix adjustments have begun to enable certain areas to be refinished, in keeping with their new use case

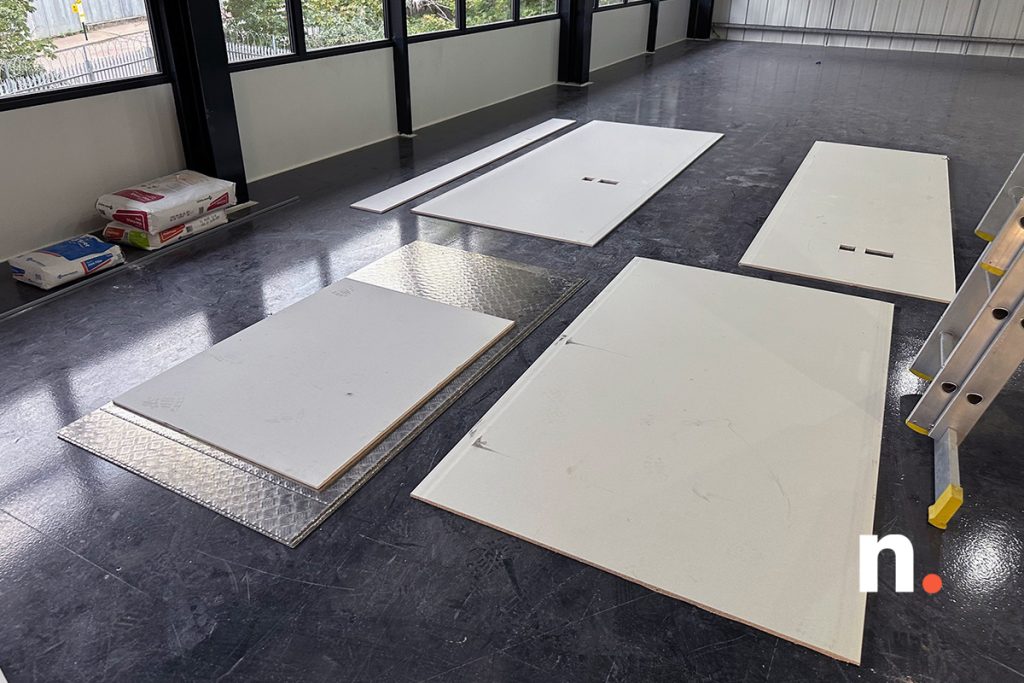

Walls
Here we see plasterboard being prepared to cover the block wall in the office area
Walls
The new surface here will form one of the new private offices, along with the glazed corridor for accessing the rest of the spaces in this area
Walls

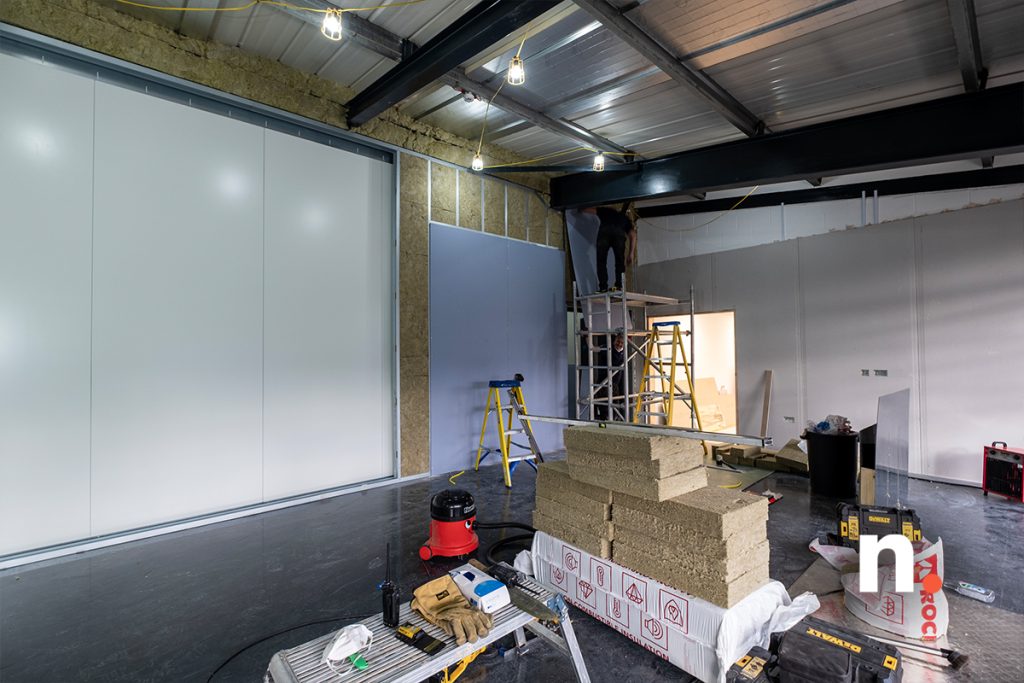

One major component of making the new office and meeting space work is acoustic treatment – there have been many engineering meetings to discuss how best to implement this, as an additional layer to the main composite wall structure
Walls
The acoustic treatment in this area creates a new isolation barrier, which will form one side of a new access corridor, leading to the offices and meeting room
Wall

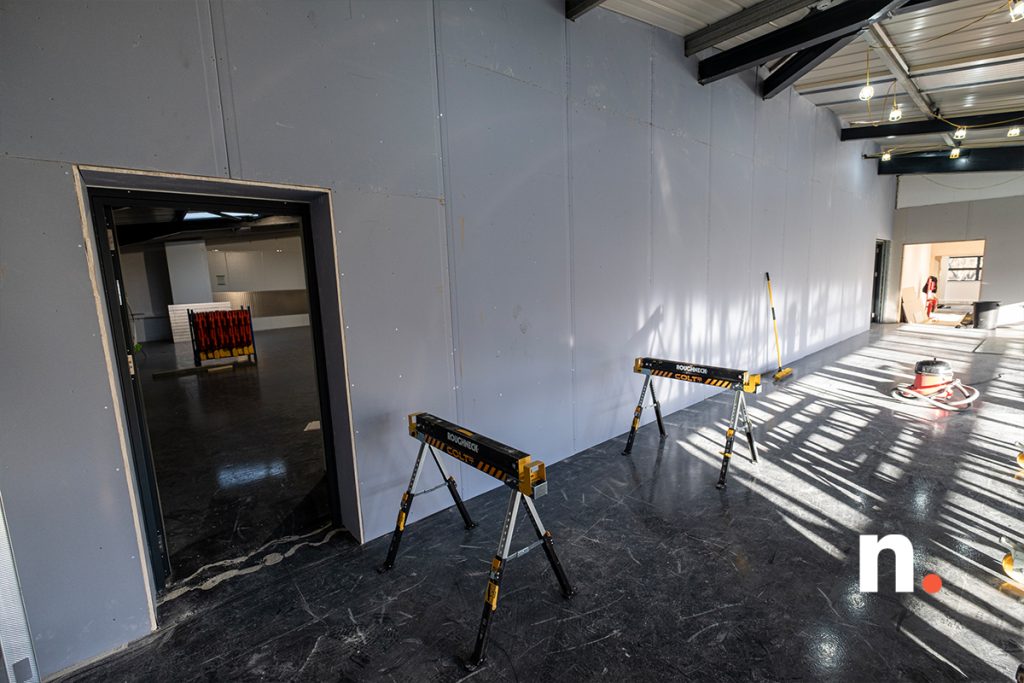

The main sound insulating wall is approaching initial completion here

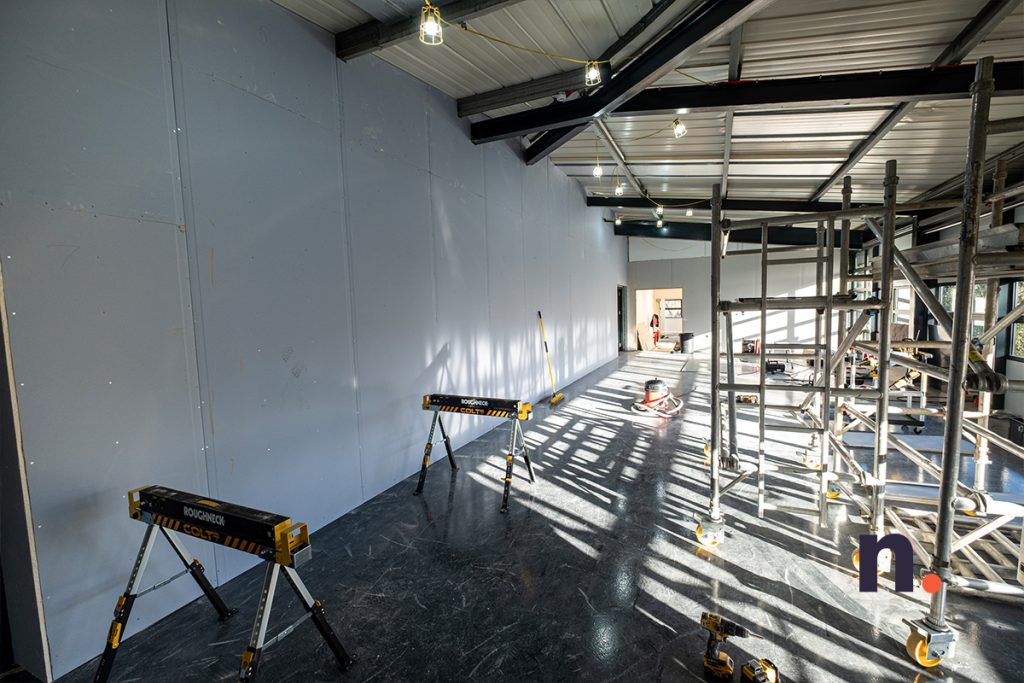

Wall
The new office and meeting room area will bring a new visual language to our facilities, as we are working with an interior designer to really make this spaces shine
Wall
This view is from the new meeting room, looking down what will be a glazed corridor leading to the offices, breakout area and second NOC
Breach
This area will be the new staff breakout and kitchen area, sitting between the new NOC space and the offices / meeting room

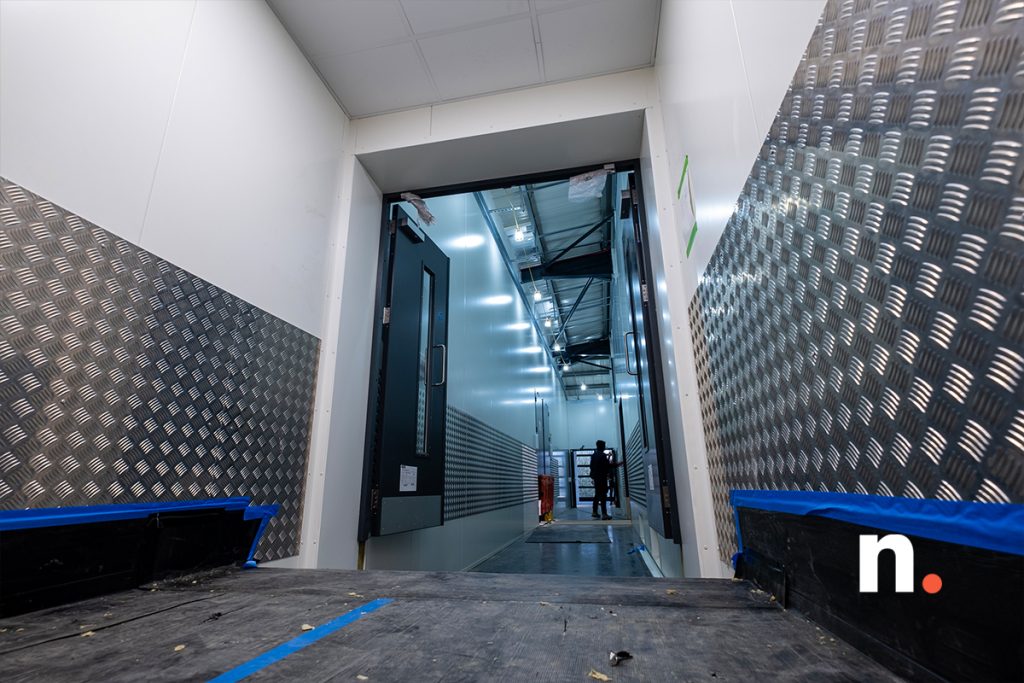

Breach

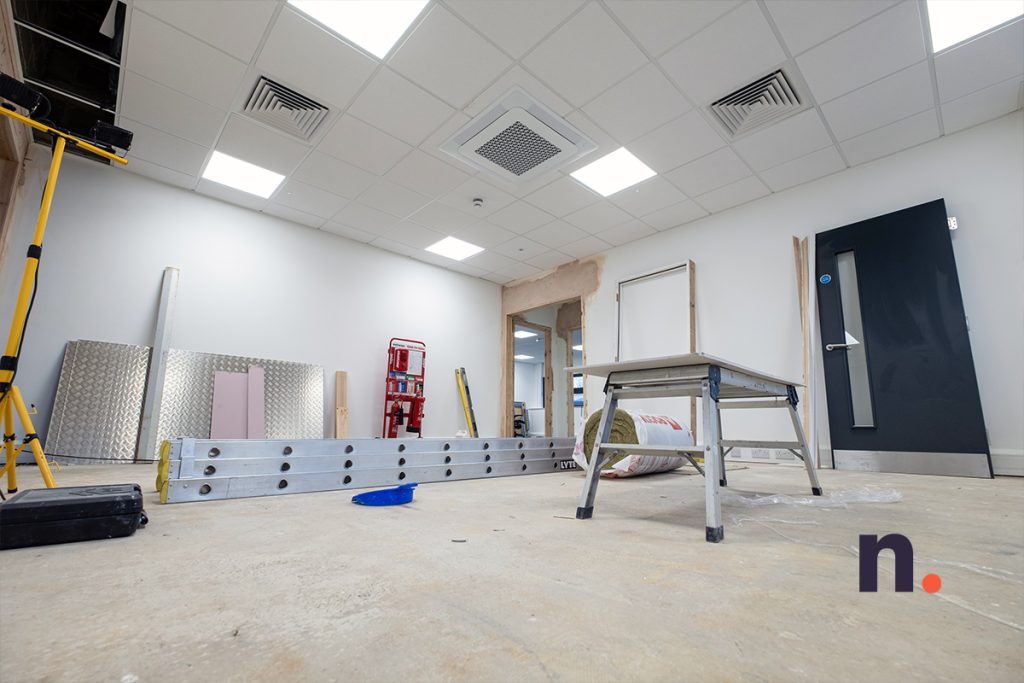

The breach points between the technical areas of the facility have now been trimmed out – this is the first floor breach point
Breach
Here we see the ground floor breach point
Breach
We’ve also trimmed out the additional breach on the ground floor which runs between the front of house and the technical spaces on the ground floor

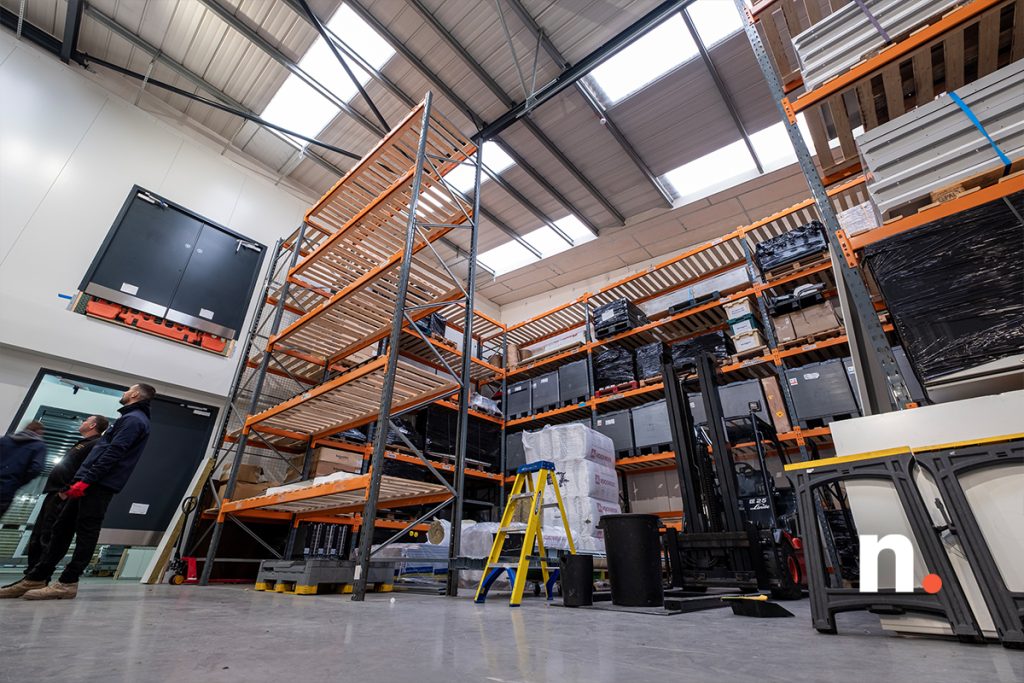

Warehouse
The racking in the new warehouse / loading bay in now complete, and is primarily used to store materials ahead of their eventual requirement as part of the build project

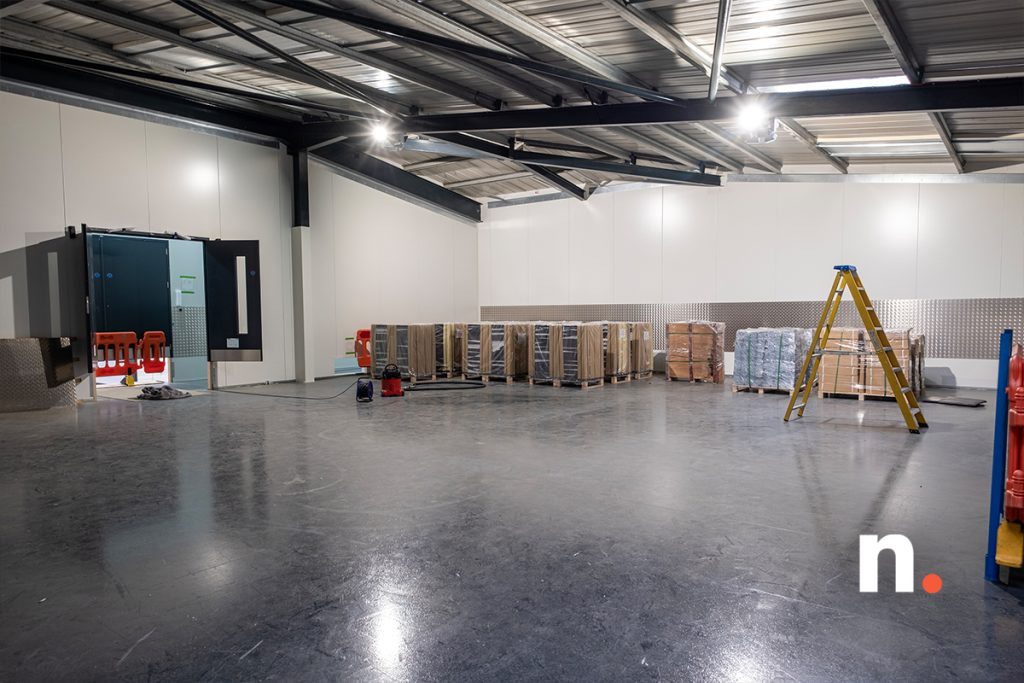

Flooring

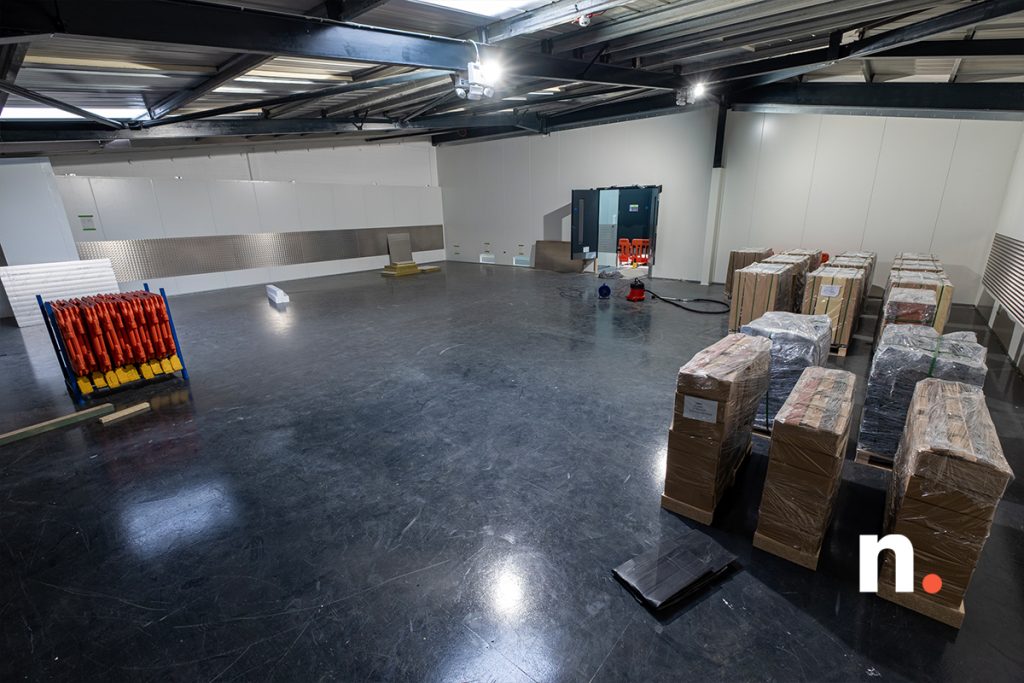

Various materials are now being distributed across the facility – the raised floor materials for Data Hall 5 have now landed in the hall to acclimate ahead of installation
Flooring
The technical spaces within the facility are set to see transformation in the early stages of 2026, as the containment works begin in full force
Walls
Further apertures have been cut for cable access in various areas throughout the facility – here we see a range within one of the new UPS rooms, ahead of final trimming

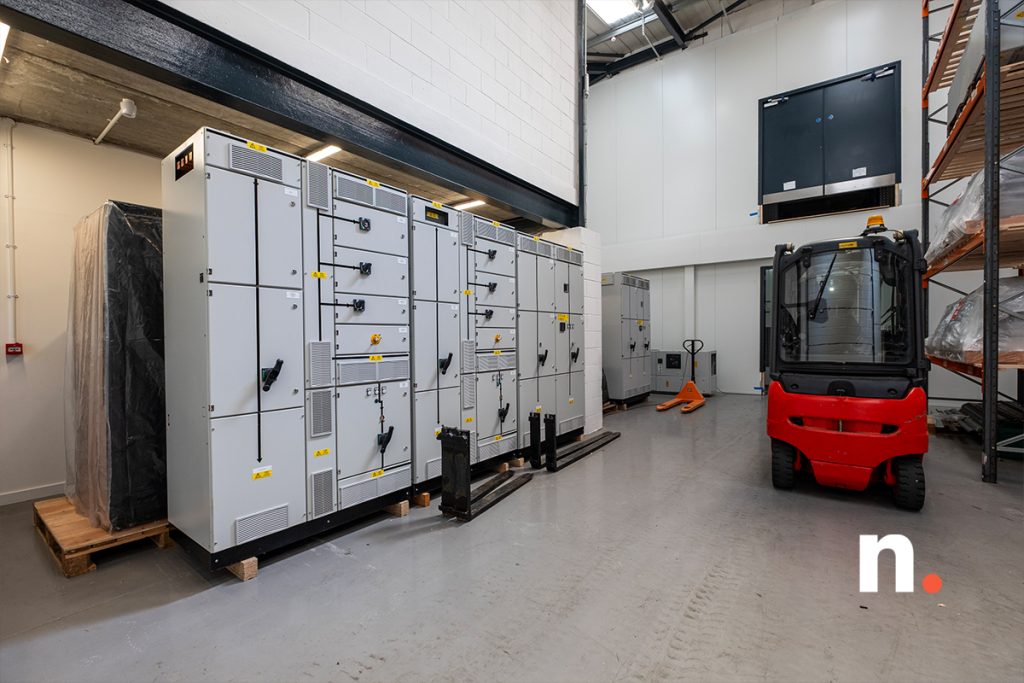

Elec
Some of the new electrical boards have started landing ready for deployment in time

We’re naturally very pleased to see progress pick back up on the Unit 5 expansion project (Phase 3), given that this had to take a backseat during the close-out of Phase 2.

In the early stages of 2026, the build schedule will move more firmly back towards technical works, as containment will begin flowing in ahead of the main flood-cabling action.


Supplementary works on the active side of the facility

In addition to the main build phases / schedules, we’ve spent time on

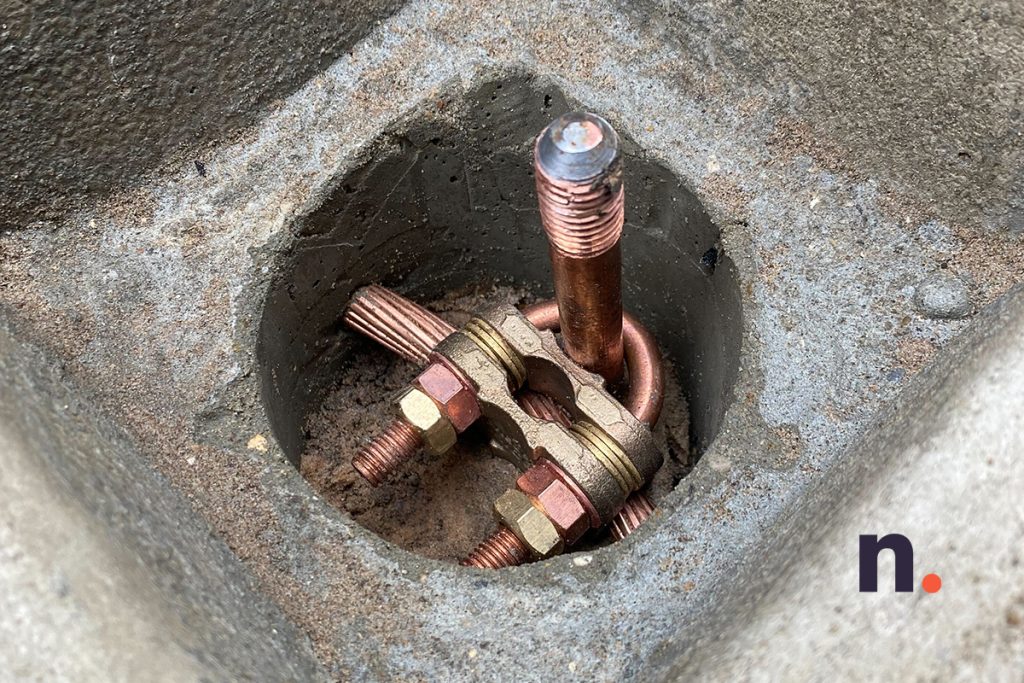

Earthing

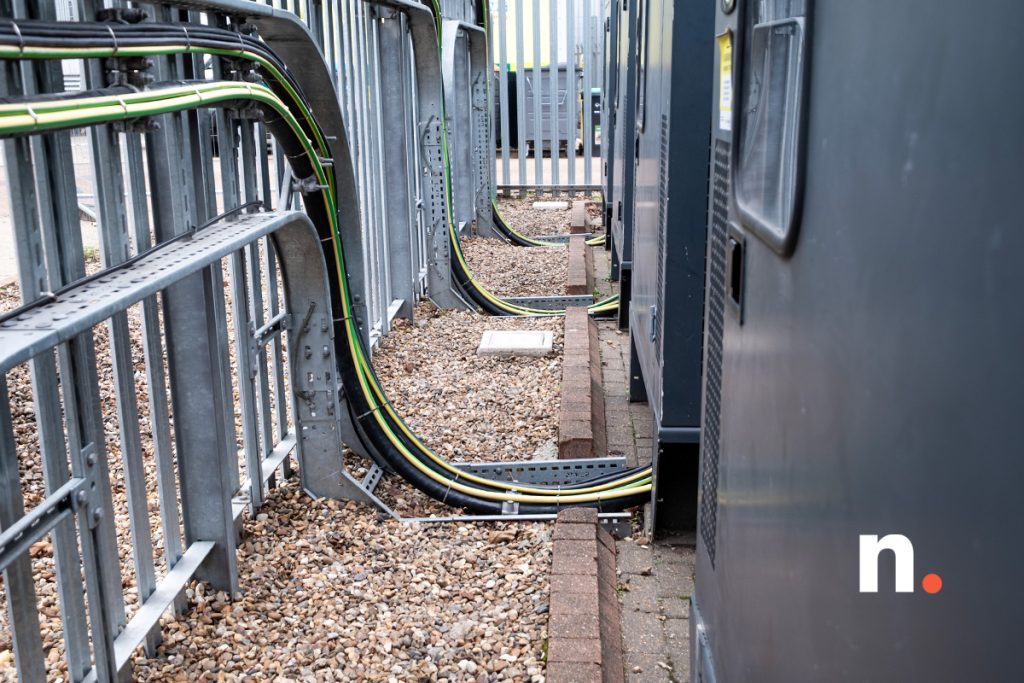

Alongside the continuation of works for the Unit 5 expansion, we’ve also had additional second-path earth deployed on the existing backup gen-sets
Earthing

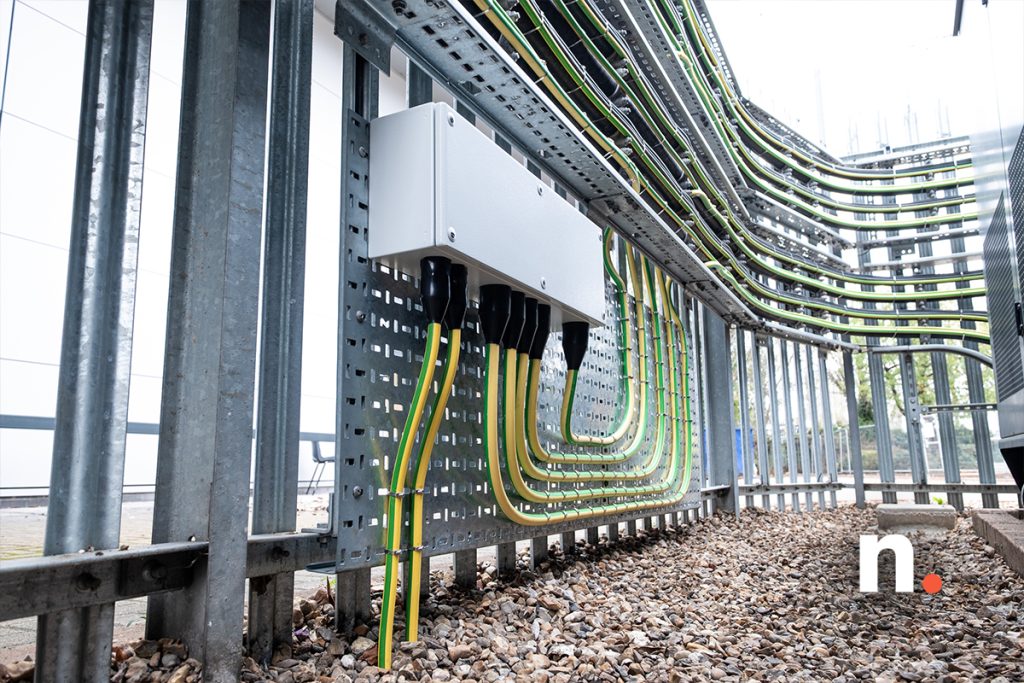

The adjustments made here were of course non-service impacting, and result in an improvement to earthing redundancy as a safety improvement on this backup power delivery system
Earthing

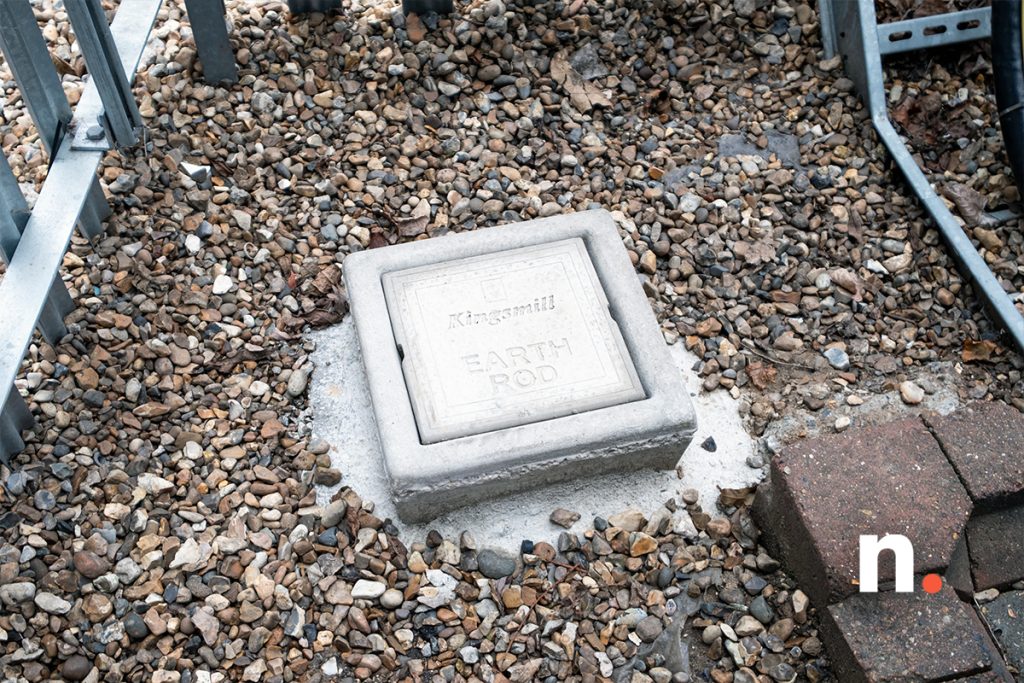

You’ll now see multiple earth pits around the generator area in Unit 6
Earthing
The new earthing rod installation is an example of iterative improvement on existing systems (as opposed to a set-and-forget mindset), and undertaken by our in-house electrical engineering team
Reception
The main client reception has seen adjustments to the check in area, to streamline the arrivals process ahead of some procedure changes landing in the new year

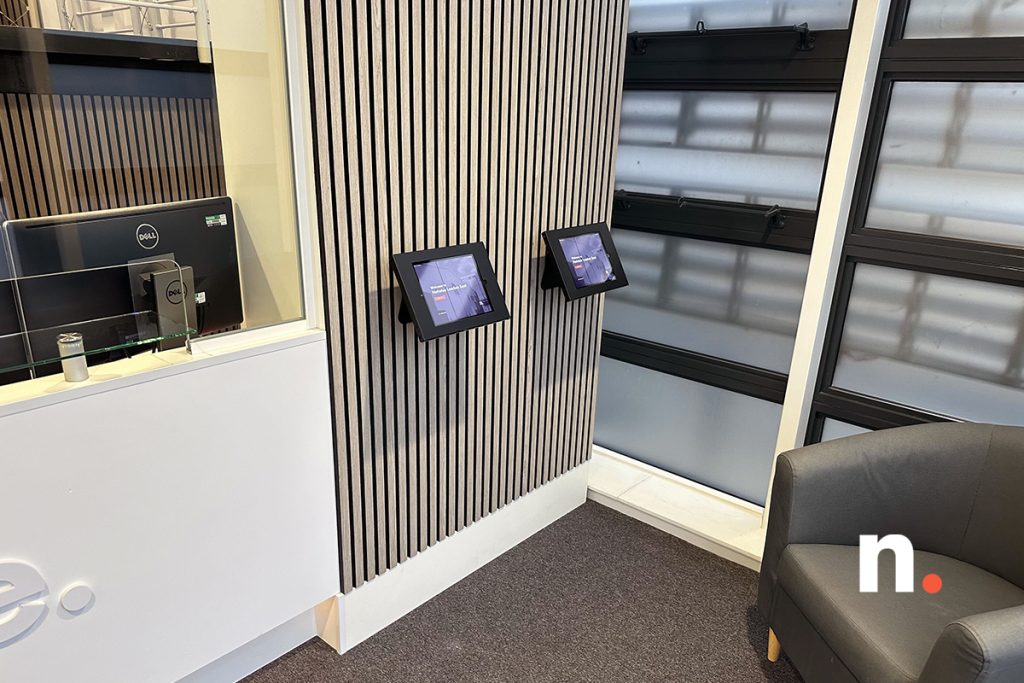

Reception
We now have a twin iPad setup for our check in app, which enables faster check in for visits with multiple engineers, or where multiple clients arrive at the same time

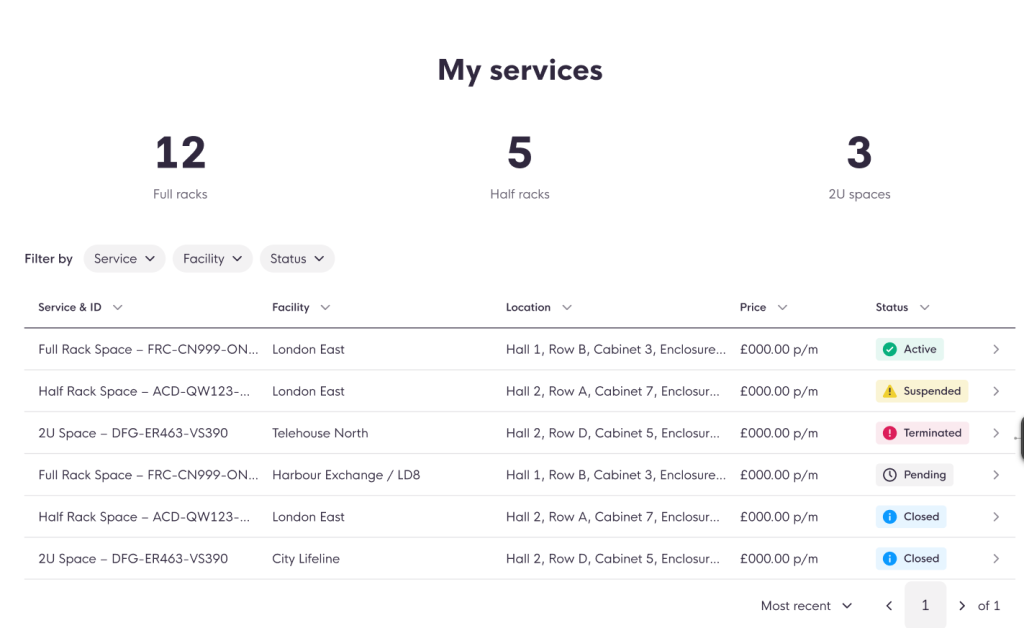

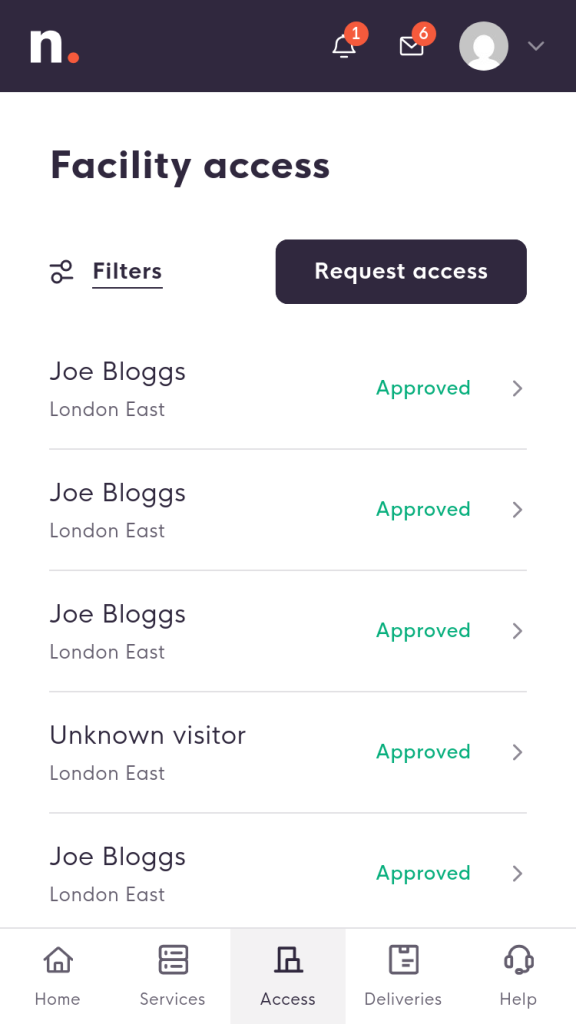

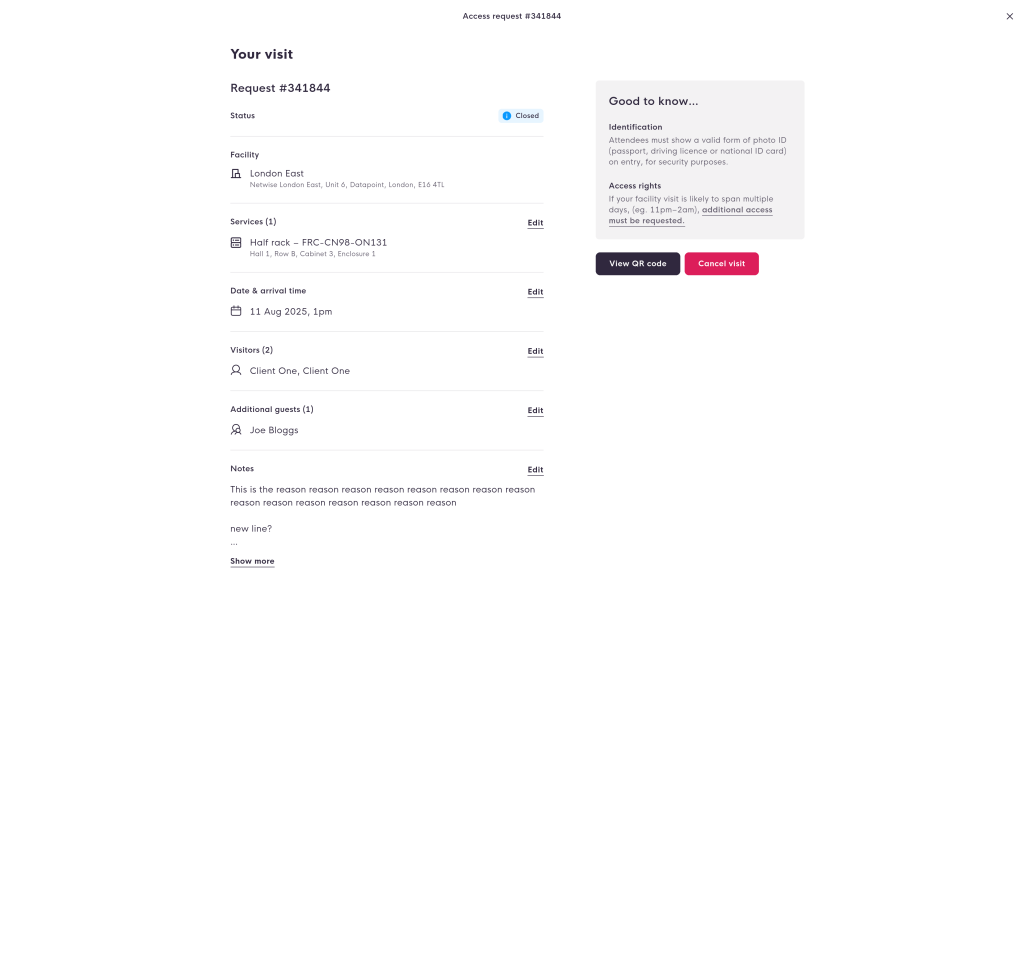

We’re also happy to leak some preview shots of our new customer portal, which is under development and will be launching in 2026. This is something that’s been in the works for a while, a collaboration between our own team, as well as a UI/UX designer, and our development partner, and we’re very excited to get this pushed out to clients next year.


More on the Unit 7 expansion

As you may have already seen from our official announcement post, we have now secured Unit 7 of the Datapoint estate, which joins Unit 5 (our current expansion project) and Unit 6 (the live footprint), creating a single ~38,000ft² facility, and giving us total control over the entire free-standing building and secure compound areas.

Work has already begun on this side of the footprint, with the initial refurbishment works now complete, and the exterior perimeter bolstered to a pre-conversion state.

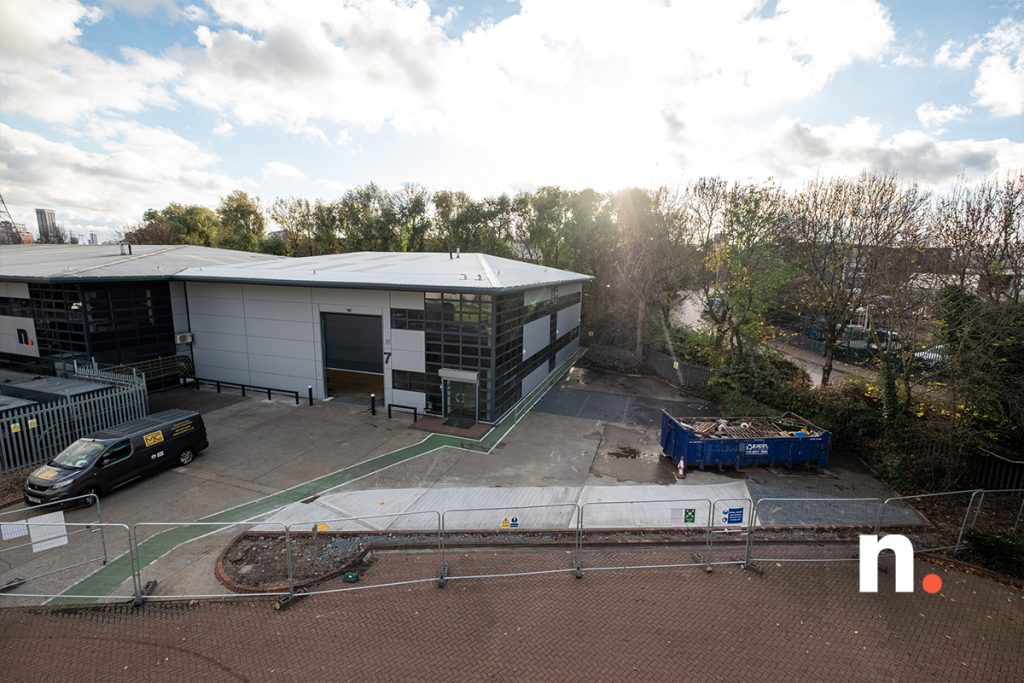

U7

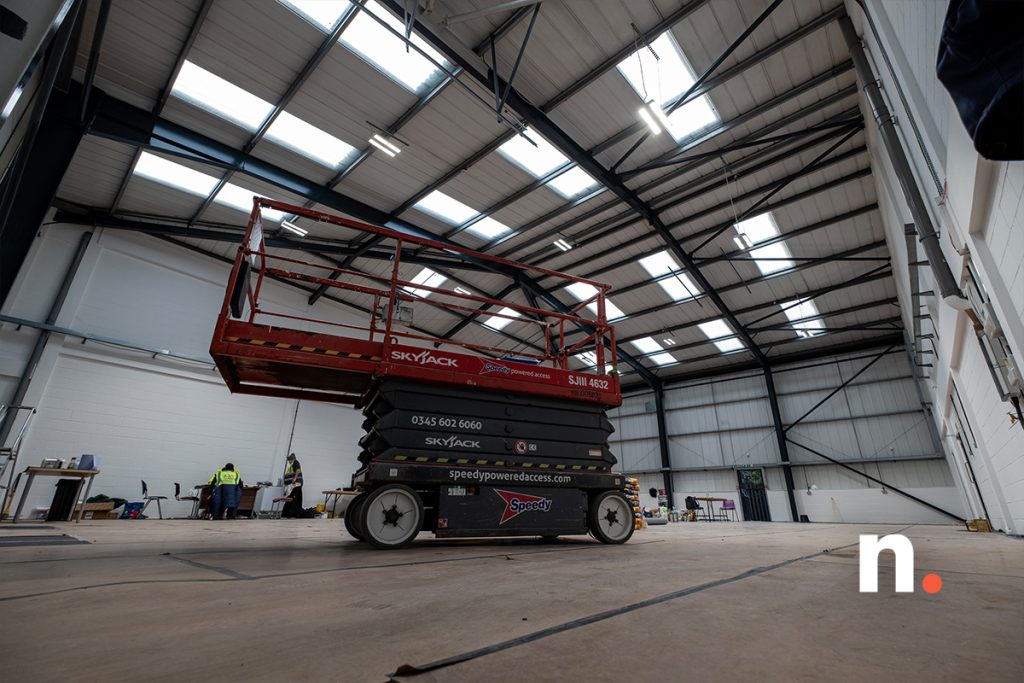

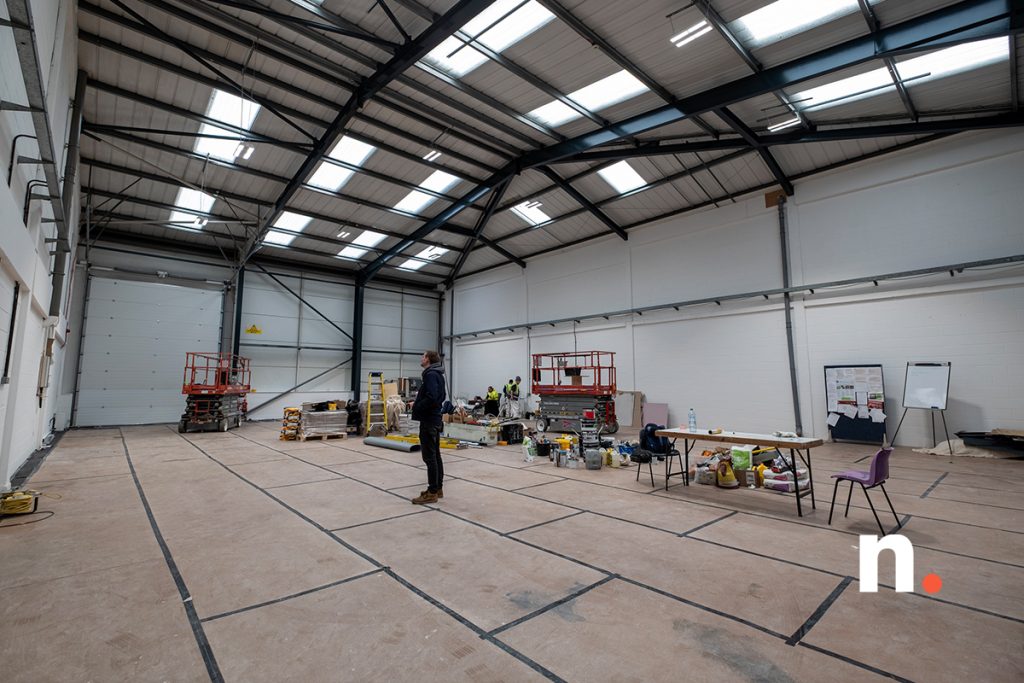

Initial refurbishment works have been undertaken in the new space, ahead of our own works schedule in due course – this readies the shell for conversion as the next phase of expansion at NLE (Phase 4)
U7
Refurbishment works spanned the entire footprint of Unit 7, including some significant layout adjustments internally to ready the space for eventual conversion
U7
A view of the front of the new space, as initial refurbishment works are undertaken
U7

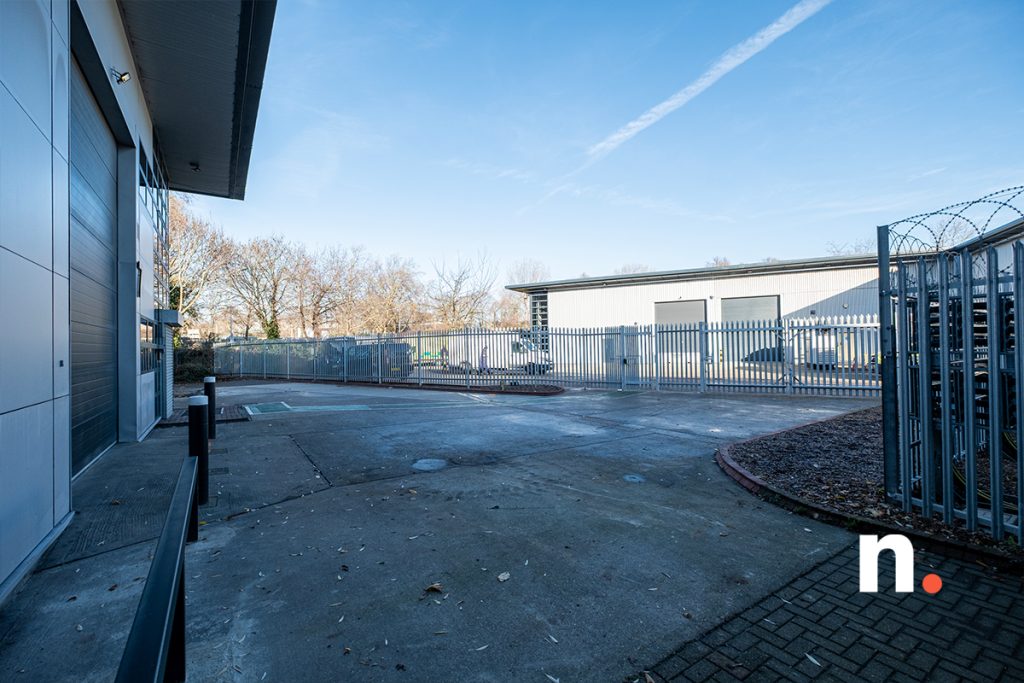

Here we see preparations underway for the new perimeter fencing, to enclose the entire NLE footprint, which required adjustments to the demise line and external slab / drainage
U7
We will be largely completing the Phase 3 expansion works in Unit 5 ahead of starting on Phase 4, however there may be some developmental cross-over later in the Phase 3 build cycle
U7
As with both other footprints that make up the London East facility, the new space brings with it plenty of opportunity for expanded amenities for both customers and staff alike
U7

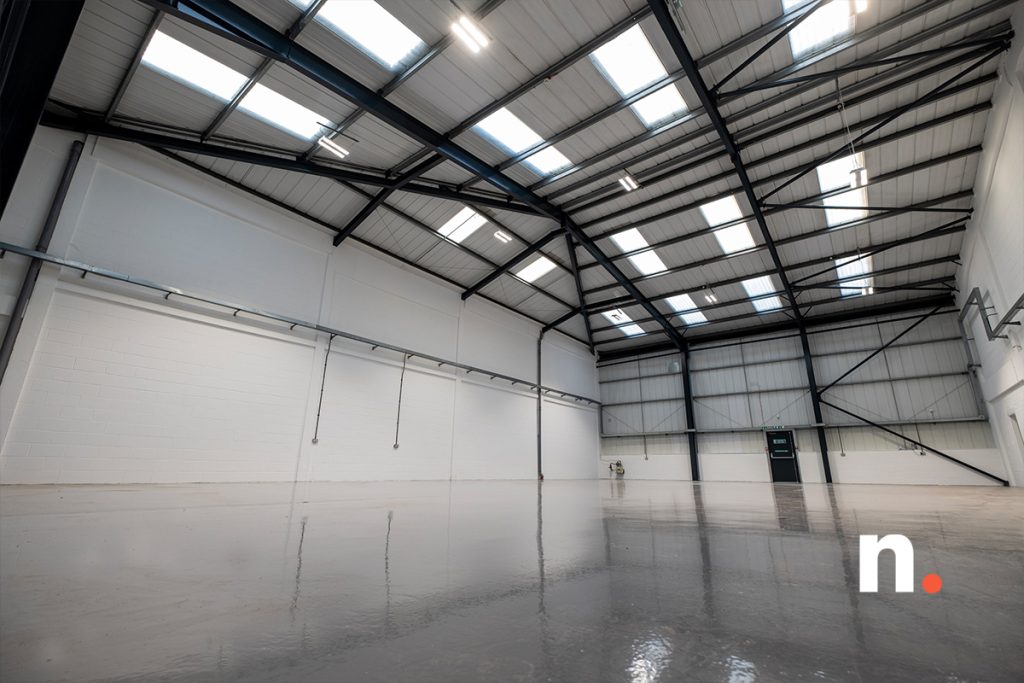

The new footprint is now back to the same matching baseline condition as the prior footprints ahead of their conversion – we’re very excited to see this new space come into the Netwise London East fold
U7
A view of the new space as seen from the corner of the front compound
U7
Taking on Unit 7 provides masses of additional compound space, which has now been fully enclosed in our palisade fencing – this will have the razor wire and our own specialise access control automation added later
U7
Having full control of the perimeter, as well as masses of additional space for parking and plant equipment, is a welcome addition to the NLE ecosystem
U7
The full-width frontage of our London East facility, which now encompasses the entirety of the south side of the Datapoint estate, makes for quite an imposing approach

We’ve had yet another incredible year here at Netwise, which we’re please to top off with a final build blog post update for our readers.

We’ll have another year in review landing in January, as is tradition, but in the meantime we’d like to wish everyone a very merry Christmas, and a happy New Year. We’ll see you in 2026 for further progress on our multi-faceted expansion schedule.

Netwise to further expand London East facility

We’re very pleased to officially announce further development and expansion plans at our Netwise London East (NLE) facility.

The ink is now dry on a deal which sees us take full control of the freestanding units on the south side of the Datapoint estate – occupying Units 5, 6 and 7 – adding another ~12,000ft2 of available data centre space.

The total NLE facility footprint now spans ~38,000ft2, and is expected to house around 500 racks across all active data halls once fully deployed.

Unit 7
Unit 7 joins prior phase developments at London East; Unit 6, Phases 1 and 2, and Unit 5, Phase 3 (the latter of which is still under development)

Initial refurbishment works are already underway in the newly acquired space, with adjustments being made to increase the front compound, and to install perimeter security to our exacting specifications.

This comes just 12 months after beginning work on our first expansion project at NLE (Phase 3), which is expected to see initial completion and client occupation in 2026, as Data Hall 5 comes online. The modular deployment of the initial expansion project will continue into 2027, with the onlining of Data Hall 6.

Updates continue to flow into our much-lauded build blog, which allows readers to follow along with a behind the scenes look at progress in active development phases. This newly planned phase of expansion works will flow into the build blog in due course.

Unit 7
The initial renovation works are well underway, to prepare the space for our future conversion works

We now have full operational occupation and control over the south side of the Datapoint estate, with both buildings either side of the active facility forming part of the London East footprint. This gives us full control over the entire freestanding building, with the full perimeter and all external areas now under Netwise authority.

The addition of Unit 7 will see the total footprint of the London East facility grow by nearly 200% since Phase 1 began in 2020.

Unit 7
As with both prior development projects, this new space will also carry with it a host of additional amenities for clients to enjoy

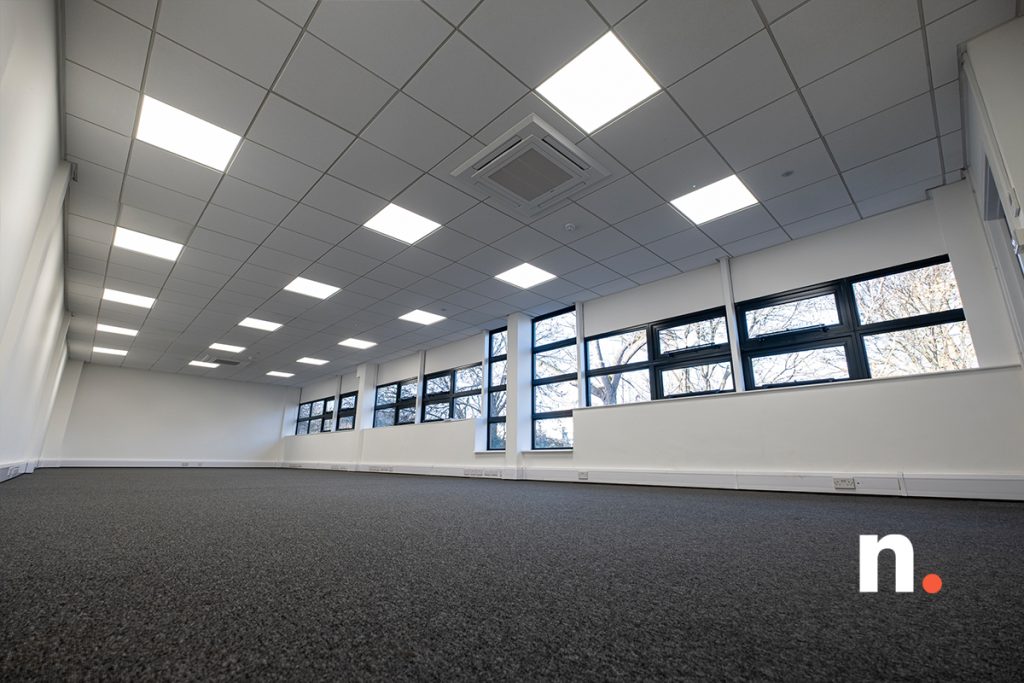

Plans for the internal fit-out of this new space are still pending. Early stage plans centre around an additional two data halls (7 and 8), which are likely to become high-density spaces to cater for increasing demand from the HPC and AI/ML sectors, particularly for inference applications that require edge facility locations in critical markets.

Unit 7
The new space will enable continued growth and expansion at our high-demand London East data centre, which sits within the UKs most important data centre ecosystem

Total power delivered to the site is to be significantly increased, with final plans and figures as-yet unannounced.

"This is an incredibly exciting time for Netwise, as we deploy further space at our flagship London East facility. The demand for high-quality data centre space in London only continues to grow, so ensuring we have maximum availability at all times - for existing and emerging deployment trends - is vital."

Matt Seaton, Director

We continue to invest heavily in the development of our portfolio across the board, as the market expands more broadly, placing increasing demand on the infrastructure that drives the modern economy.

Unit 7
Adding Unit 7 to our London East estate is the final piece of our property control plan for this location

This multi-pronged approach to growth and development within the organisation has been a cornerstone of the Netwise formula since day one, with an in-house team capable of managing a wide range of ongoing projects concurrently.

"Our aim has always been to take full control of the south side of the Datapoint estate. Adding Unit 7 to the London East footprint sees this plan through, giving us maximum flexibility over where we take the next chapter of the London East story. We're extremely excited to see continued growth here at our flagship London data centre. With Netwise turning 16 this December, we have much cause for celebration."

Matthew Butt, Managing Director

Having additional capacity available in London’s ever-popular data centre ecosystem is vital for growth-minded operators in this sector, as demand for critical infrastructure continues to outpace sector build rates. Staying ahead of the curve and building world-class facilities that clients from all across the globe can rely on is of paramount importance as we look towards the next decade.

You can follow along with early stage progress on our build blog – keep an eye out for updates as we head into 2026.

London East – End of Phase 2 Development

In this instalment of the Build Blog, we look at the closure of Phase 2 development works here at Netwise London East.

The updates here take us from June to present day, as the first new clients now prepare to move critical systems into our newly launched data hall. Data Hall 3 is the fourth and final hall to come into service in the active side of NLE, with Data Hall 4 launched ahead of Data Hall 3 (for various technical and logistical reasons), in mid-2024.

Phase 3 development works continue, as we prepare for the launch of Data Halls 5 and 6 in 2026, as part of our new expansion project. Updates on Phase 3 have slowed slightly as we turned attention to closing out Phase 2, and onlining Data Hall 3, which is now ready to receive incoming deployments.

Here are the update photos from the close-out of Phase 2:

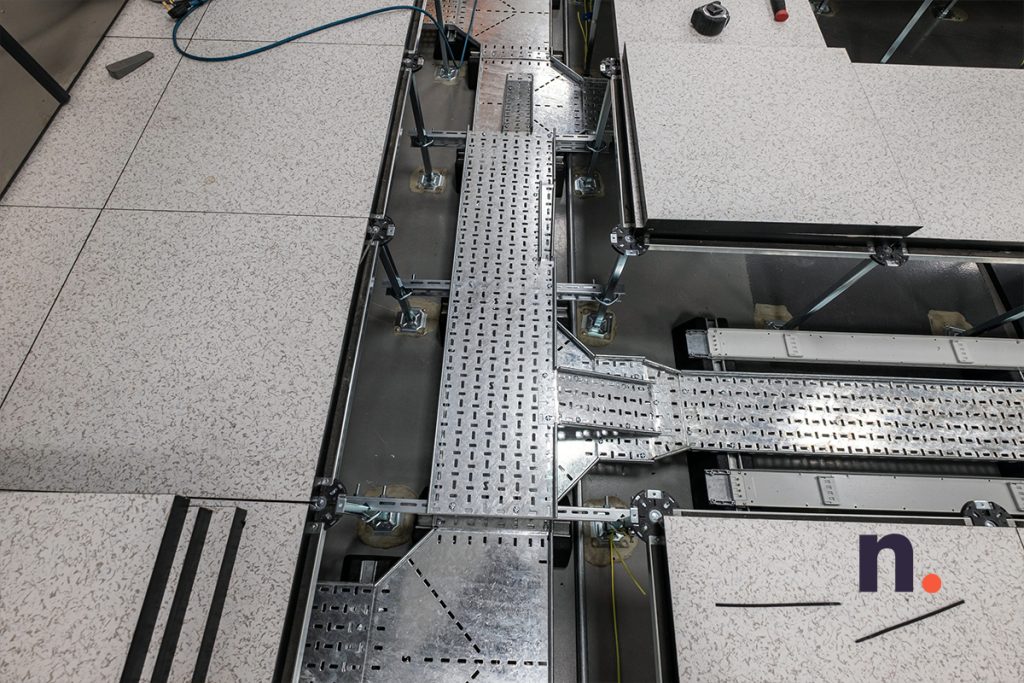

Completing Data Hall 3

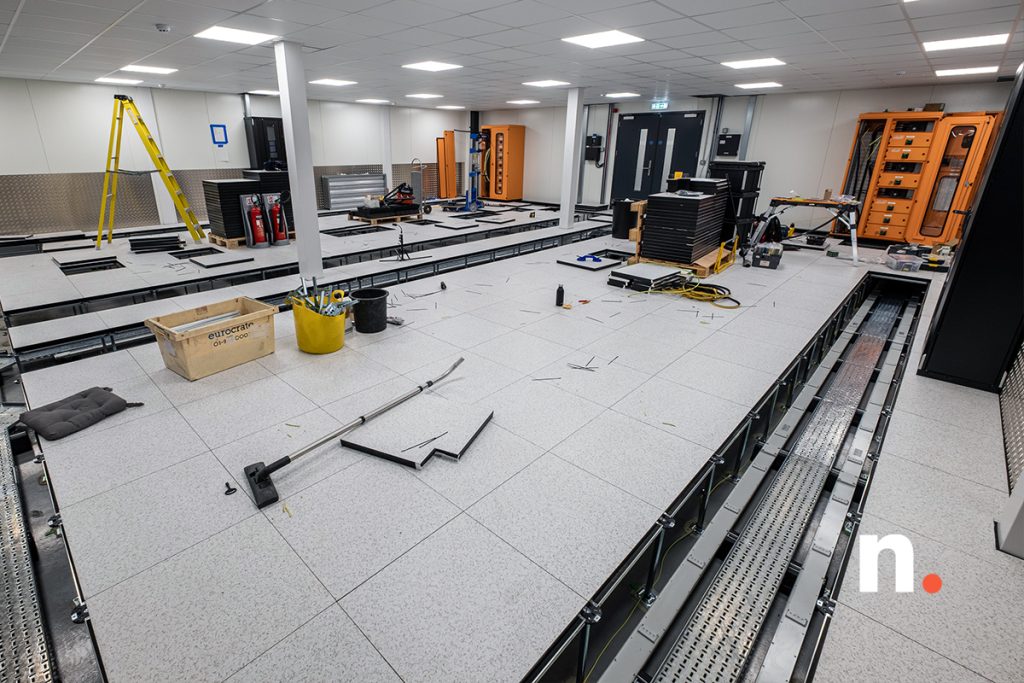

First we step back to the height of the summer, as the underfloor works are completed, ahead of cooling plant siting, followed by the commissioning of all key systems.

Power
The under floor containment and cabling works are well underway at this stage
Power
Data Hall 3 utilises the same under floor power delivery system as found in Data Hall 4, which is now approaching capacity
Power
This view across Data Hall 3 shows the two eventual containment pod locations, on the left and right floor islands seen here
Power

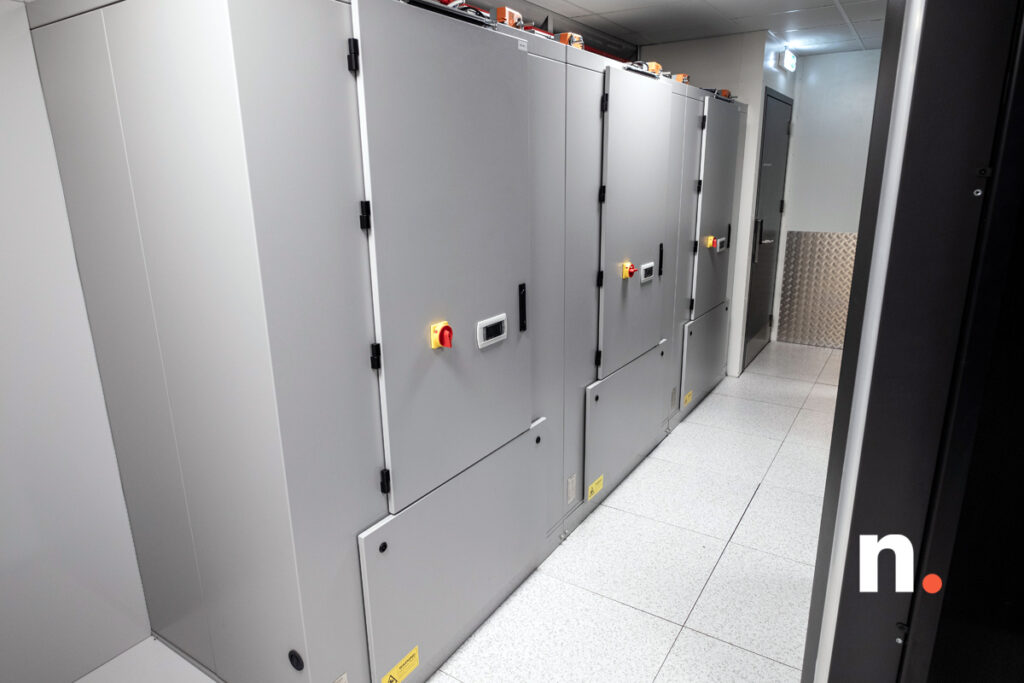

One side of the power distribution system for energising racks can be seen here, as termination and testing works continue
Power
Neat installations are not only a visual delight, but make ongoing maintenance and testing much more straightforward – our in-house electrical team take great pride in their termination work
Power
Here we see more pleasing visual symmetry under floor, which often comes hand-in-hand with redundancy, whereby two (or more) identical systems are deployed in tandem
Power

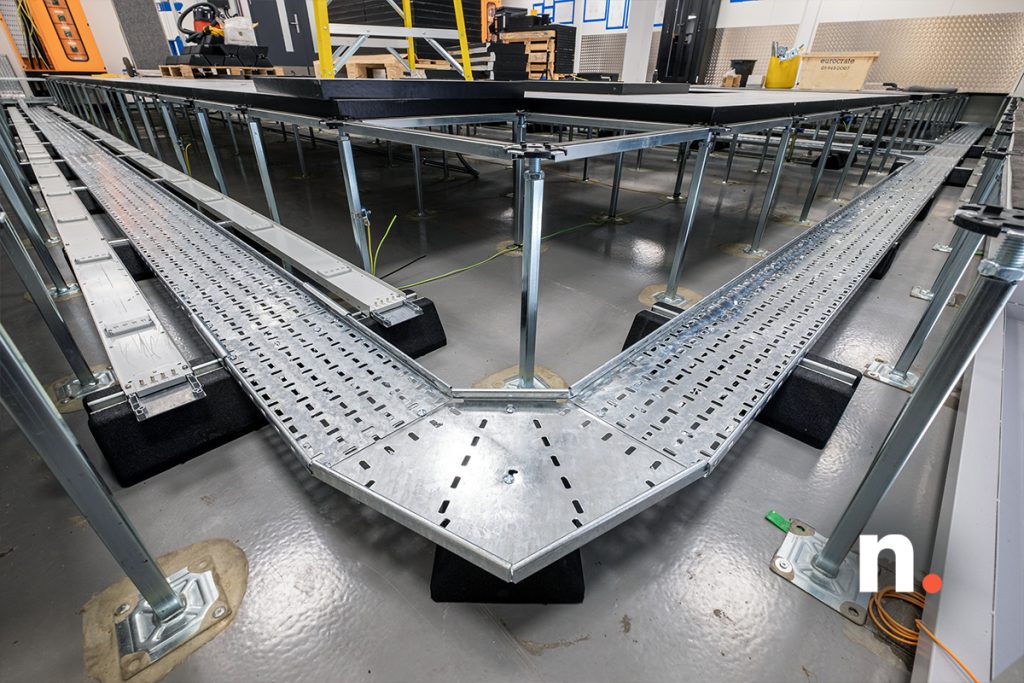

Our under floor tray work is always a source of pride for the team here at Netwise, which is why we opt to install strategically-placed glass floor tiles once the hall is complete, to ensure this work isn’t covered and forgotten, and can be further enjoyed by our clients
Power
Seeing newly laid and dressed cabling on expertly installed containment is always a joy for our team and clients alike
Cooling

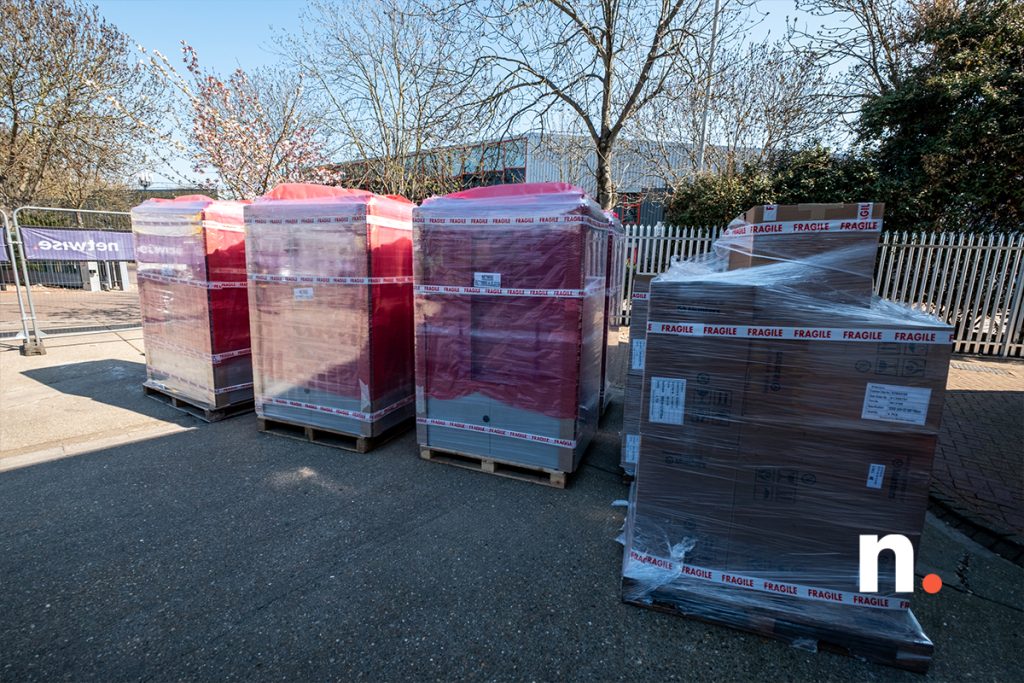

The freshly positioned CREC system for Data Hall 3, now sat on their pre-installed downflow plinths, ahead of full commissioning
Cooling
Another view of the newly landed CRECs, ready to be commissioned and tested, after some final cooling containment works in the surrounding area(s)
Cooling
The rear of the newly landed CRECs, as the backside containment and connections are set to begin, along with the finalisation of initial air filtration
Cooling

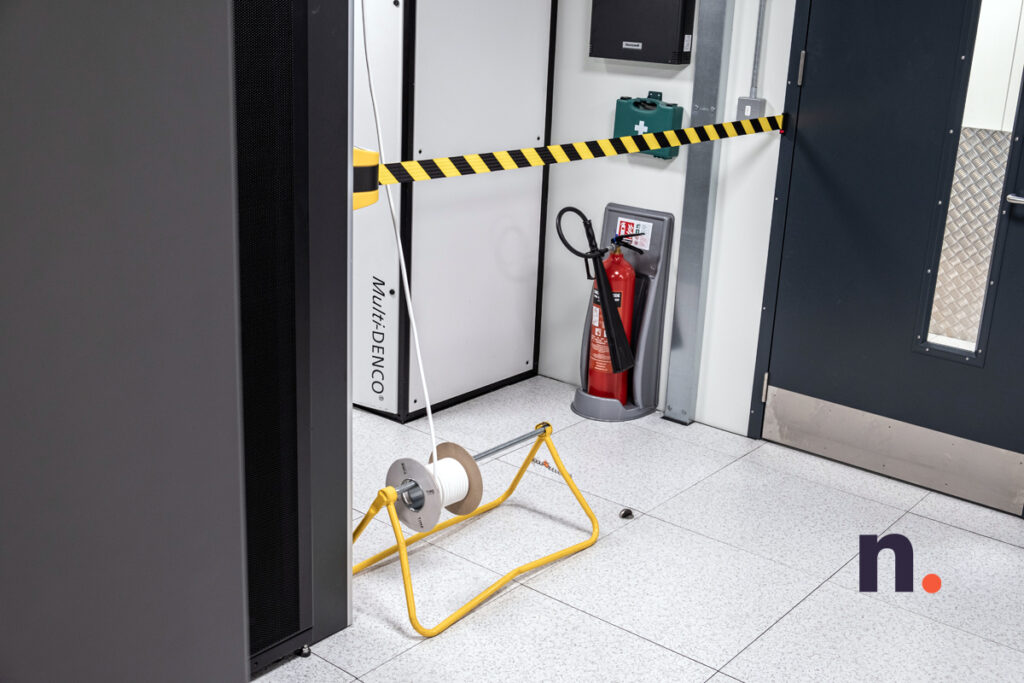

Once the final infills and containment tasks are complete, the primary cooling system will be ready to commission and test in full, including soak testing

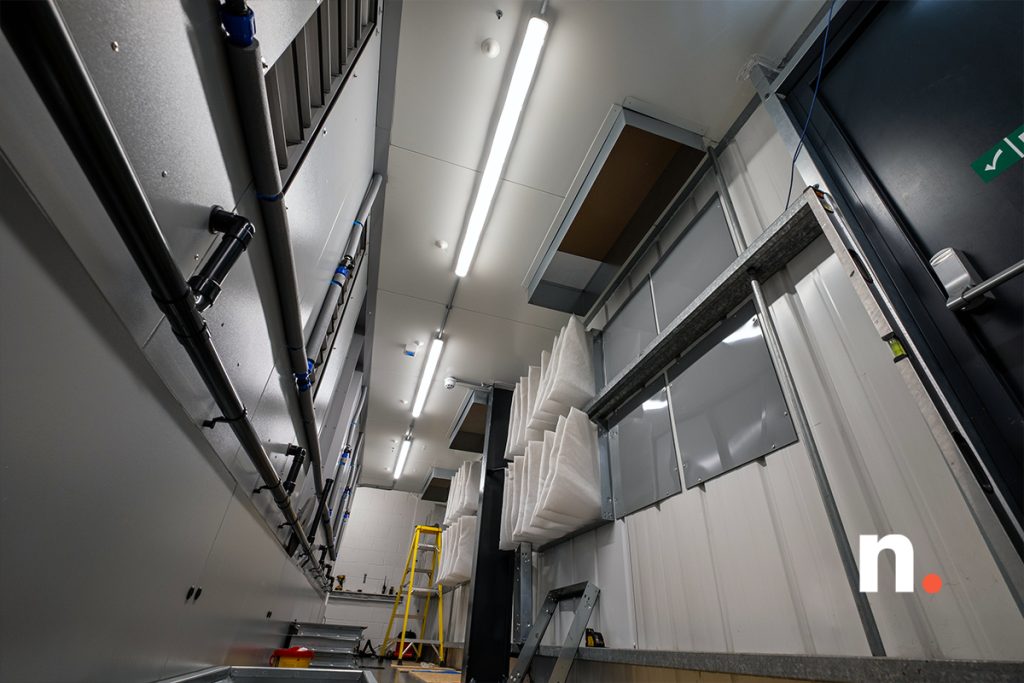

After completion of the under floor works, overhead works (not shown here), and a few other ancillary actions to ready the space, we rolled in the racks and installed the containment systems for each pod.


Phase 2 works complete

Here we see Data Hall 3 completed and commissioned, with the first client systems due for deployment imminently, including expansion projects for existing customers, as well as new clients who have had space in reservation.

DH3
Data Hall 3 sits on the ground floor, next to the ground floor breach into the new extension (Phase 3), the door to which sits behind the temporary hoarding seen here – Data Hall 6 will be located just beyond this new ground floor accessway
DH3
The completion of Data Hall 3 brings the Phase 2 deployment schedule at London East to an end
DH3
The temporary obscuring vinyls on the glass vision panels within the entrance doors have now been removed, signalling total completion of the space
DH3
Pod 1 within Data Hall 3, now complete and ready to receive pre-reserved client systems
DH3
Pod 2 shown as completed, which is also ready for new client deployments
DH3
A view across from Pod 2 to Pod 1, with some of the power distribution on show in orange, along with the supplementary CRACs
DH3
The B-side ODF can be seen on the left here, which will handle all B-side connectivity distribution for client deployments within this new space
DH3
A view down the full run of CREC units, now delivering controlled cooling to both containment pods at the highest possible levels of efficiency
DH3
As with all other data halls within the active side of the facility, both pods each contain 28 pre-deployed rack footprints, with Pod 1 holding all of our segregated rack options (quarter and half racks)
DH3
The inside view of each containment pod shows the floor grills, which will be adjusted as the hall fills, along with key monitoring systems, including temperature, humidity, pressure and particulates
DH3
The A-side ODF sits alongside Pod 1, mirroring the B-side ODF alongside Pod 2 shown previously
DH3
The backside view of the cooling system post-commissioning, in a spun down state here (hence the closed intake louvres), with completed plumbing and drainage shown

We’re extremely proud to have reached full available capacity within the currently active data centre footprint at London East, following our initial build in 2020-2021 and subsequent modular deployment schedule.

We look forward to welcoming a whole host of exciting new clients into this space, and can now focus our build efforts back towards Phase 3, which will see the onlining of Data Hall 5 in 2026, along with a range of new facility amenities for clients and staff to enjoy.

Keep your eyes peeled for further Phase 3 updates soon, along with a big announcement about further expansion at London East beyond 2026.

London East Phase 2 Development Update 7

Phase 2 development works have picked up at our London East facility in the early stages of 2025, as we prepare to bring Data Hall 3 online. This will be the final hall as part of Phase 2, before full focus turns to our main expansion project, which will see the addition of Data Halls 5 and 6 – this will be Phase 3.

Phase 3 is already underway – starting in early December 2024 – and will run in tandem with the final stage of Phase 2. You can see our Phase 3 posts published so far here on our build blog.

As Data Hall 3 will be the final hall to be onlined in the current side of the building, we’re expecting a somewhat speedy deployment schedule, given that many aspects of the fit-out process were completed as part of the Data Hall 4 schedule. As Data Halls 3 and 4 share the ground floor, there were certain deployment synergies which allowed for progress on both halls at the same time, much like upstairs with Data Halls 1 and 2. This approach will carry over to Data Hall 5 and 6 in the new expansion, as part of the Phase 3 schedule.


Earlier Phase 2 Works

Here are some photo updates, starting with the primary cooling system upgrade works for each active data hall, which happened in mid-2024:

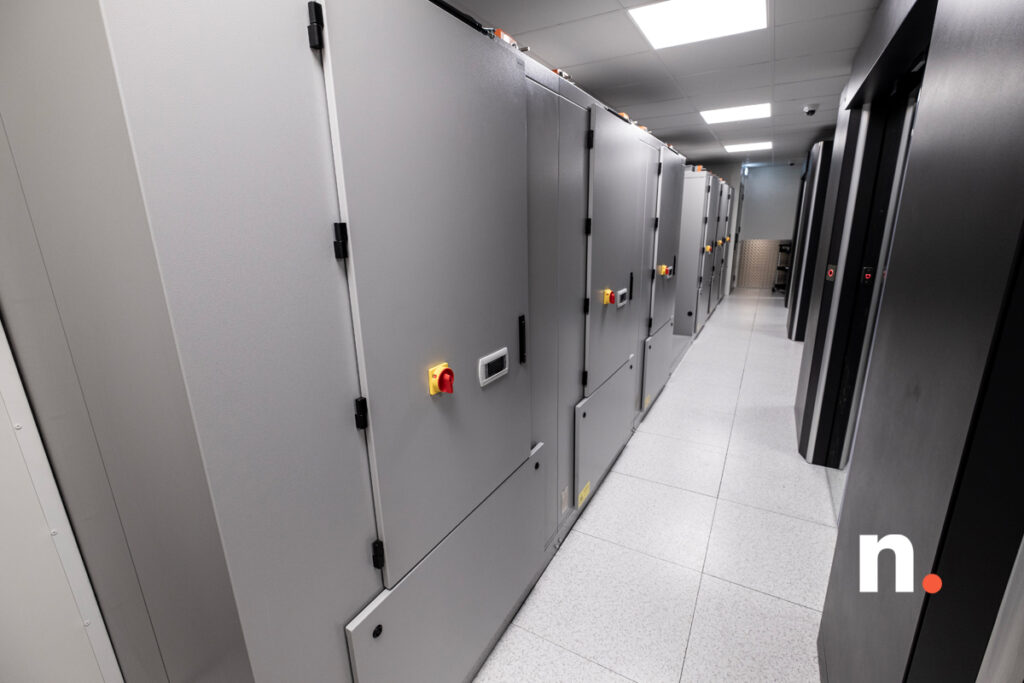

Cooling

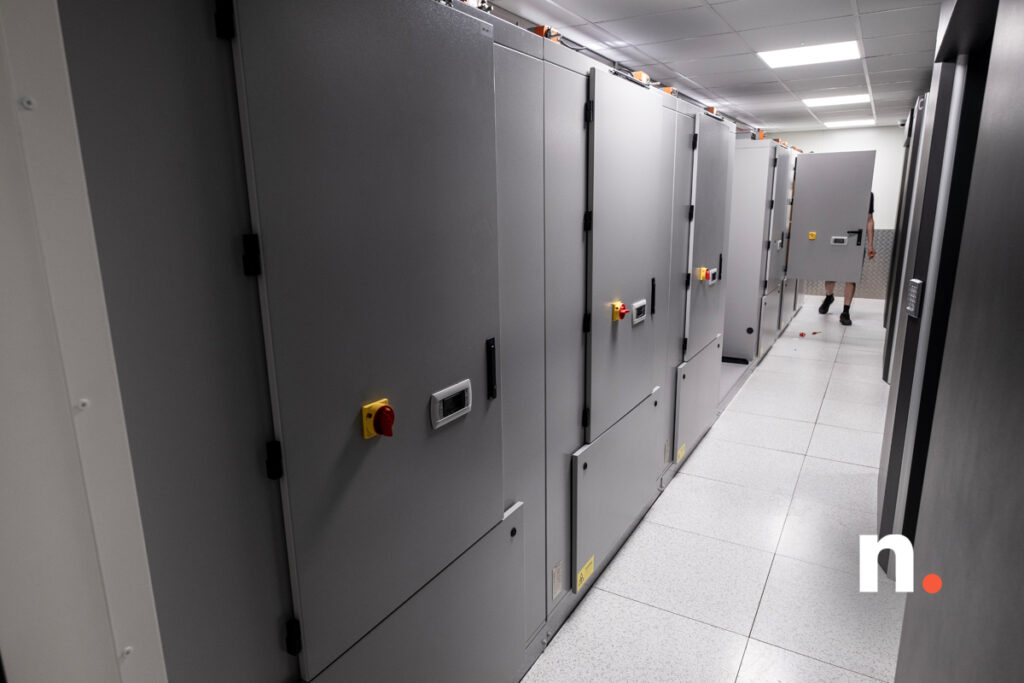

One aspect of Phase Two involved the upgrading of our CREC systems in all active data halls, moving from four live coolers in each hall to six
Cooling

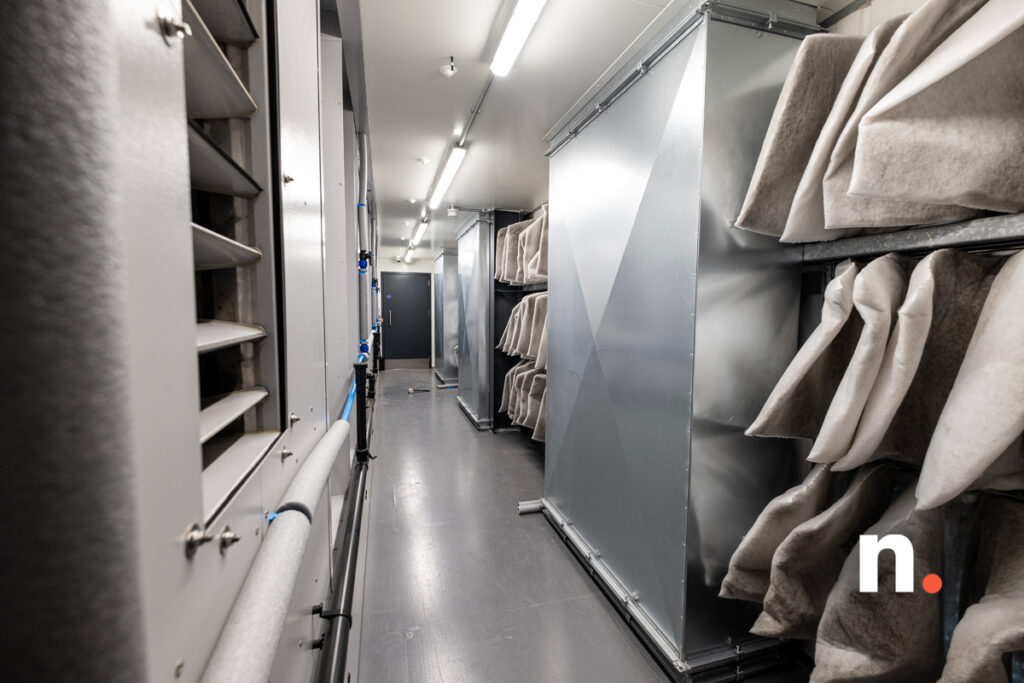

This part of the Phase Two development schedule involved deploying six new CRECs across the three active halls
Cooling
This upgrade to the primary cooling system in each hall comes as a result of growing load in each of the spaces, as each active hall meets or approaches capacity
Cooling

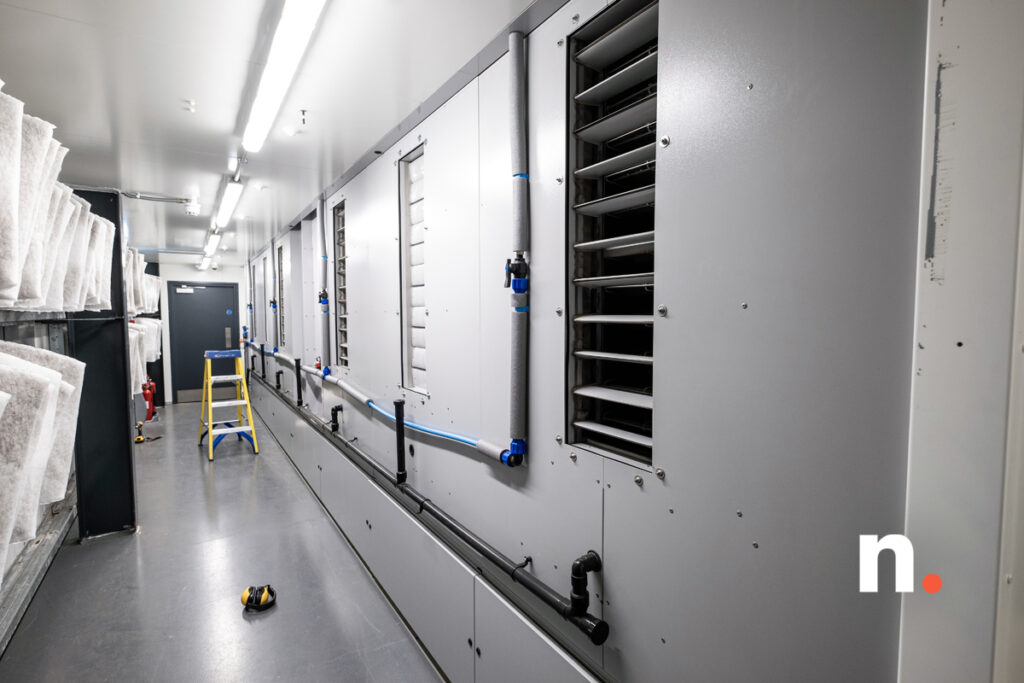

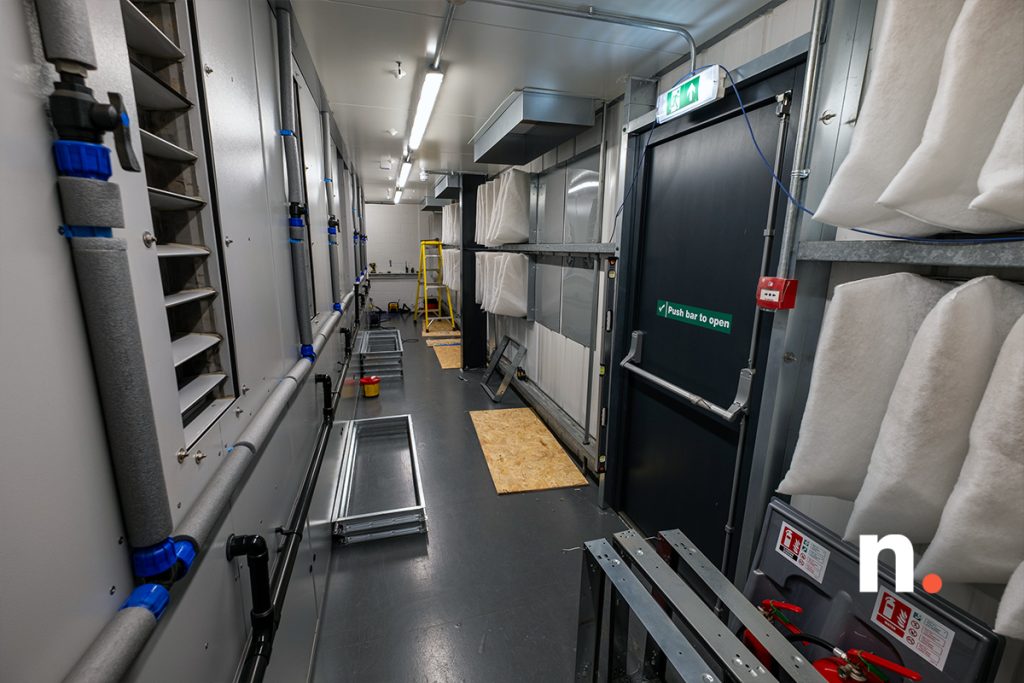

Here we see the view from the cold corridor in Data Hall 1, as the new coolers are prepared for commissioning in mid-2024
Cooling

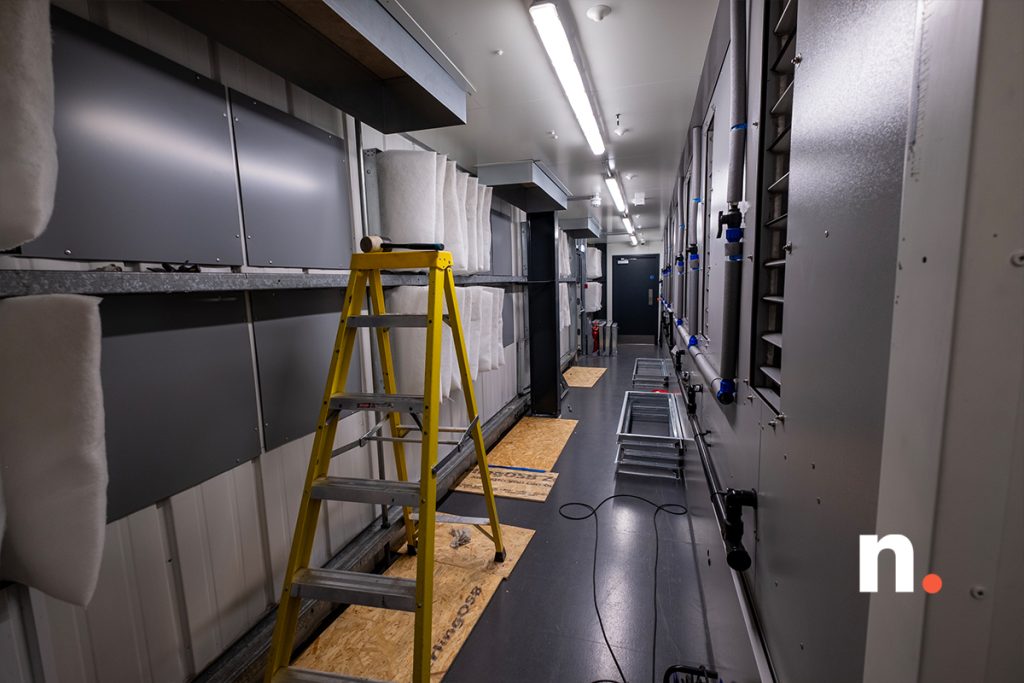

Here we see the cold corridor in Data Hall 2, with the new hot air extraction system in place for exhausting non-return hot air from Data Hall 4
Cooling

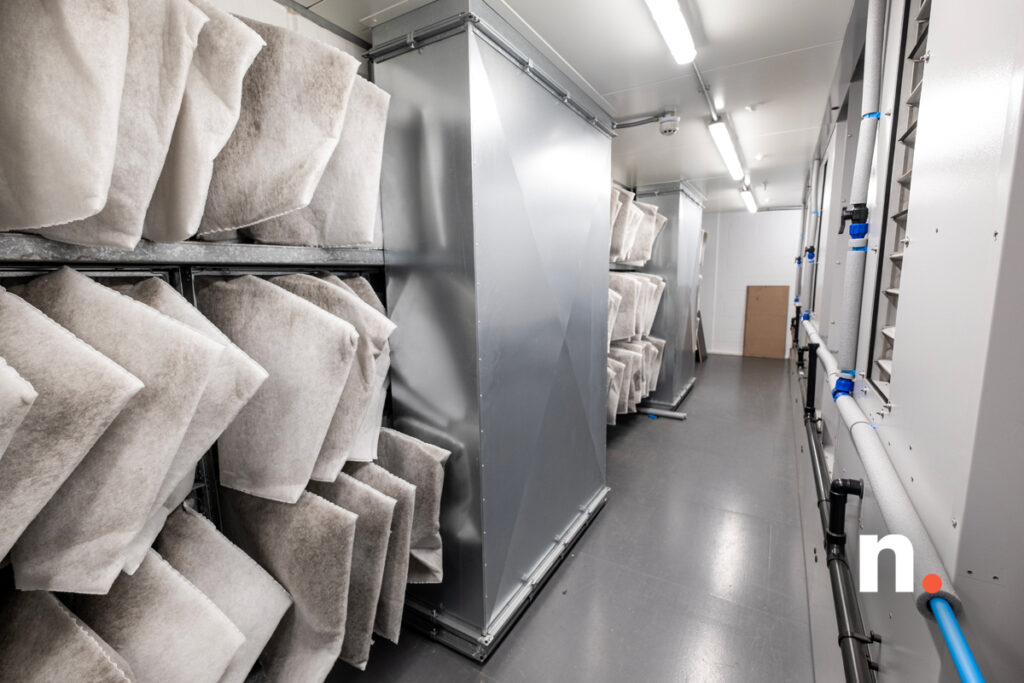

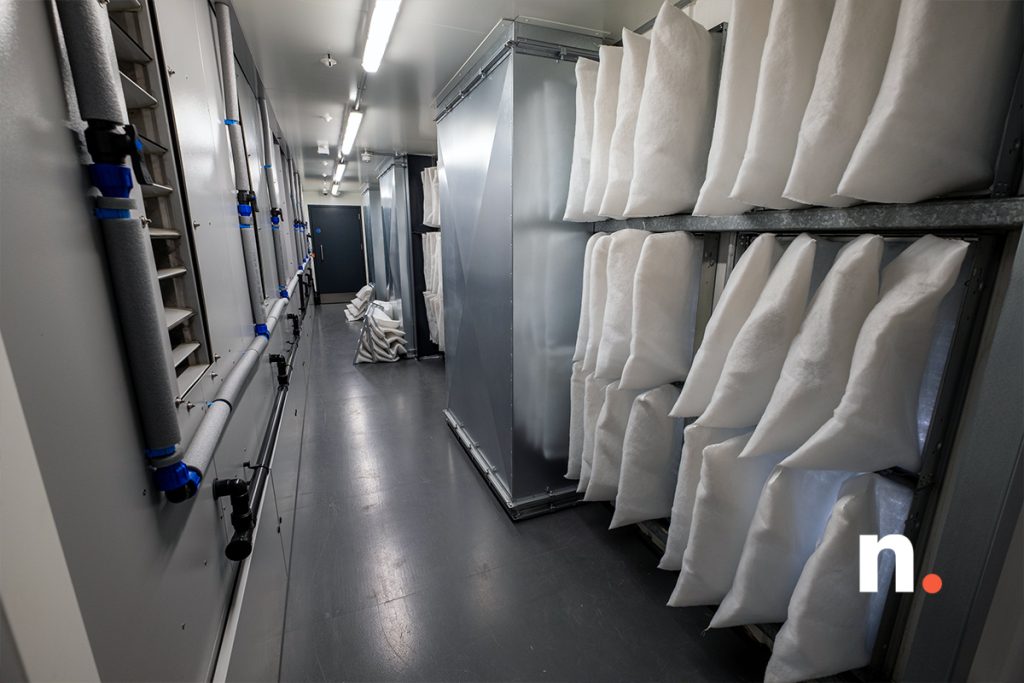

We also increased the number of intake vents and first-stage filters in all data halls, to handle the increased throughput of the upgraded CREC system in each live hall
Cooling
As part of the upgraded primary cooling system in each data hall, additional control system cabling has been installed as part of the commissioning works, which has enabled a greater degree of system-wide interplay and monitoring
DH3

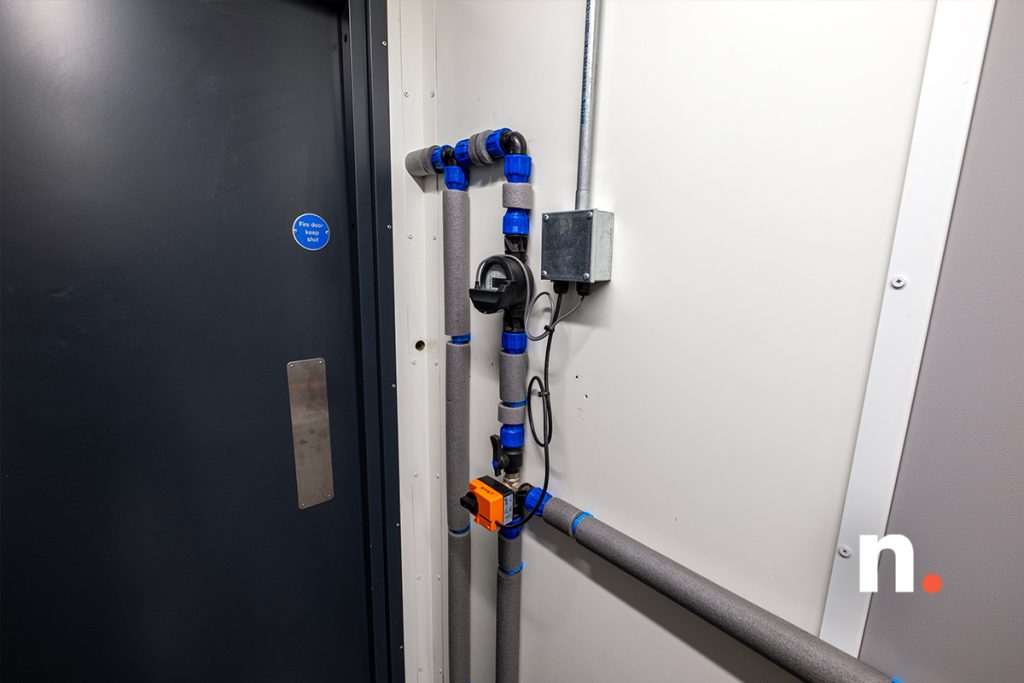

All data halls now have water meters in place to enable the measurement of WUE metrics, which sit alongside PUE metrics as important measures of efficiency and sustainability – water supply capacity has also been increased

Later Phase 2 Works

We can now take a look at more recent build progress in Data Hall 3:

DH3

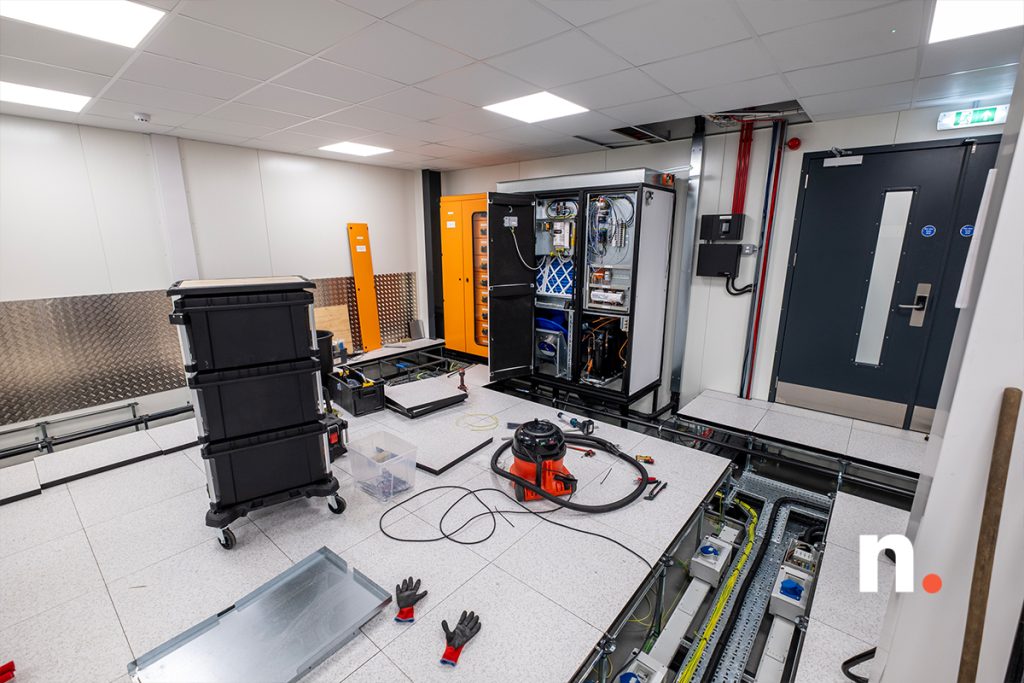

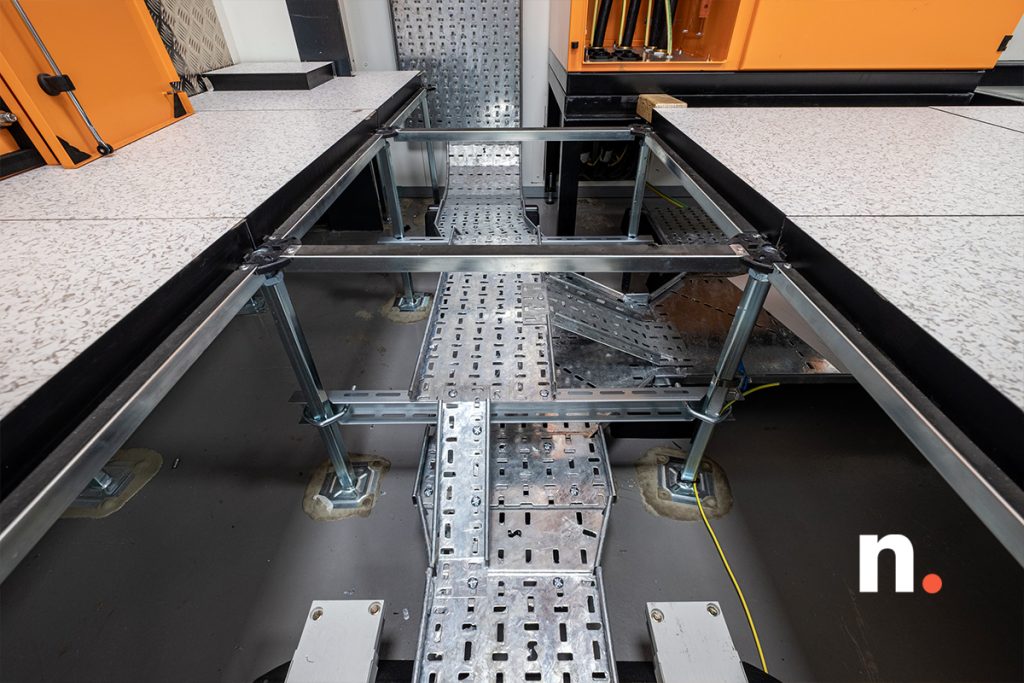

One of the first elements of installation focus for Data Hall 3 centred around the power distribution
DH3

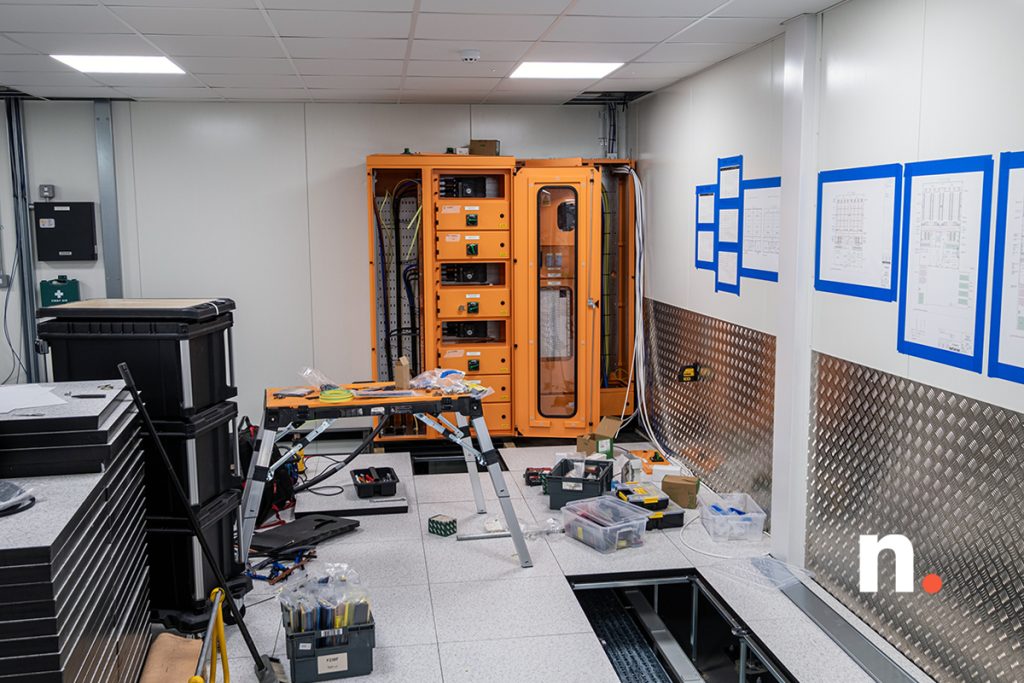

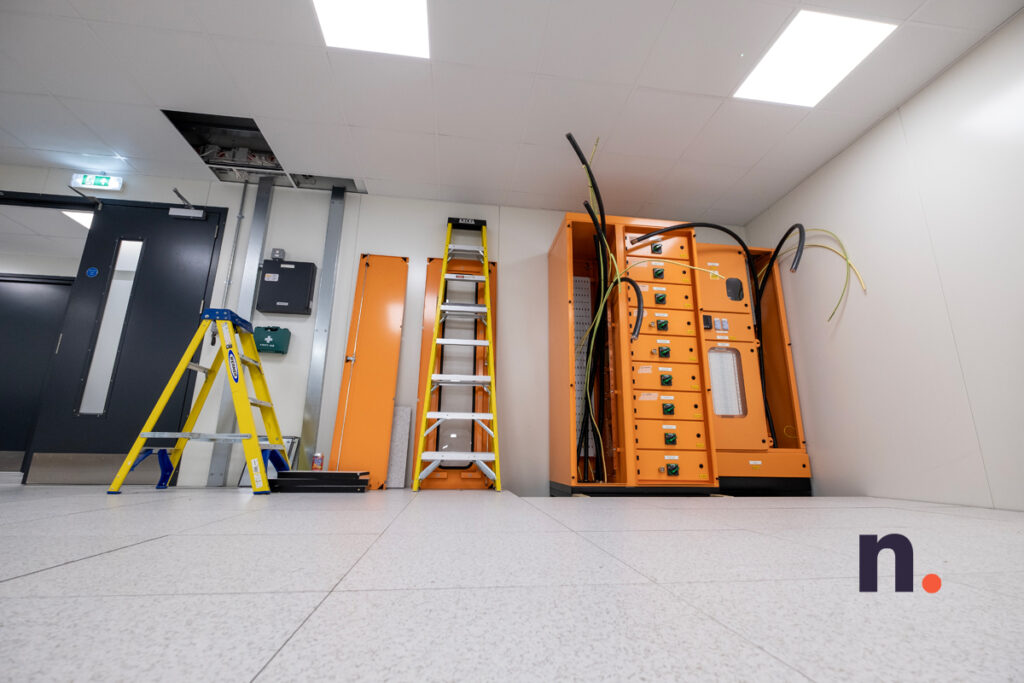

Both A and B feed power distribution boards have been situated (along with the separate dual-fed mechanical board), with termination of the main feeds to follow
DH3

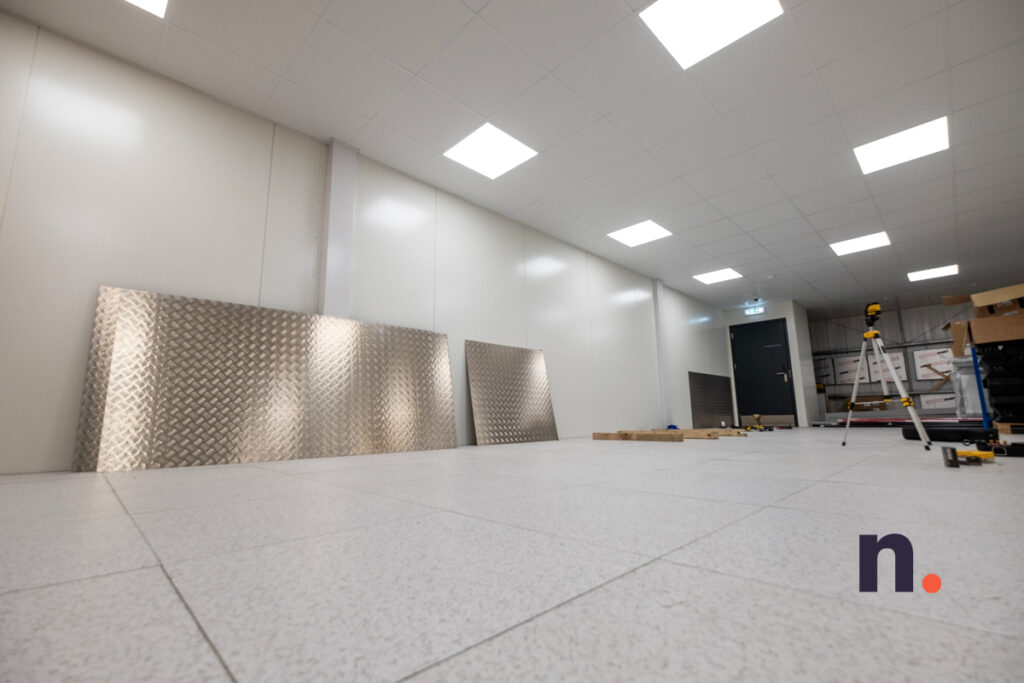

Here we see the checker plate wall protection install underway
DH3

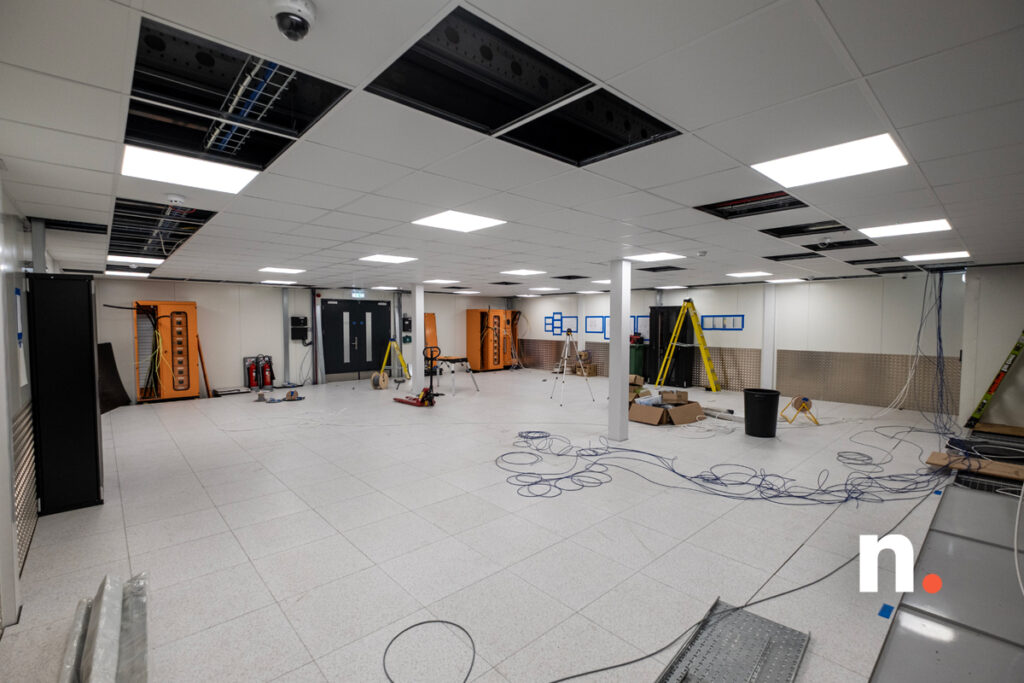

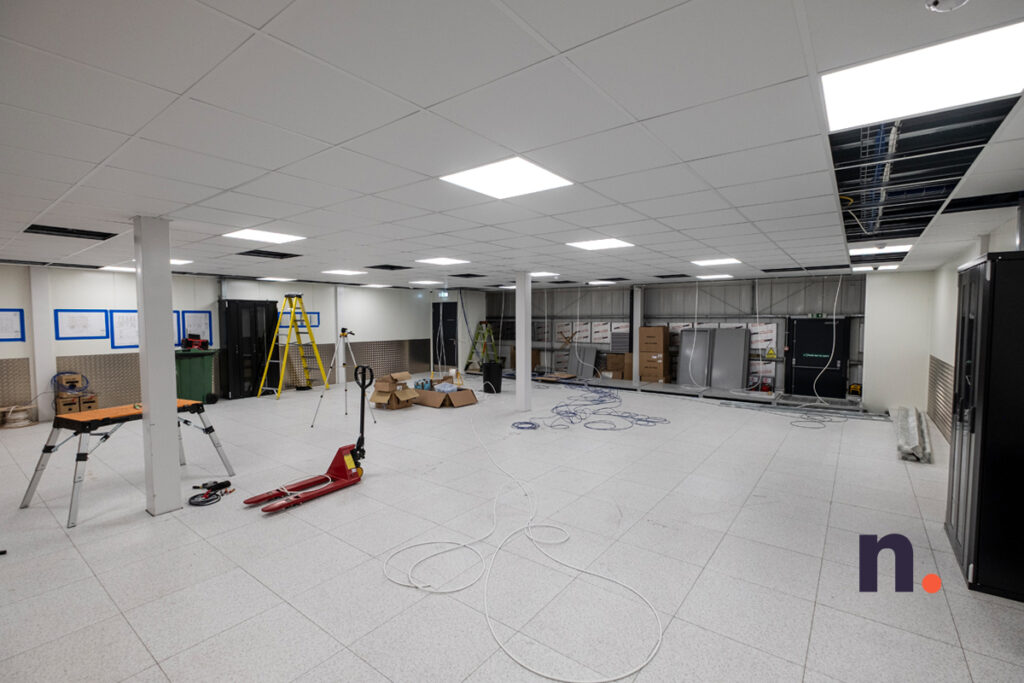

Here’s a wider view of works underway inside of Data Hall 3, with overhead flood-cabling in progress
DH3
Both ODF A and B have been installed at this stage, along with all supporting cable containment
DH3
The view towards the back of the hall, where the primary cooling system will be situated – the intake vents can be seen pre-cut, with temporary insulated blocks inserted until ready for filter frame installation
DH3

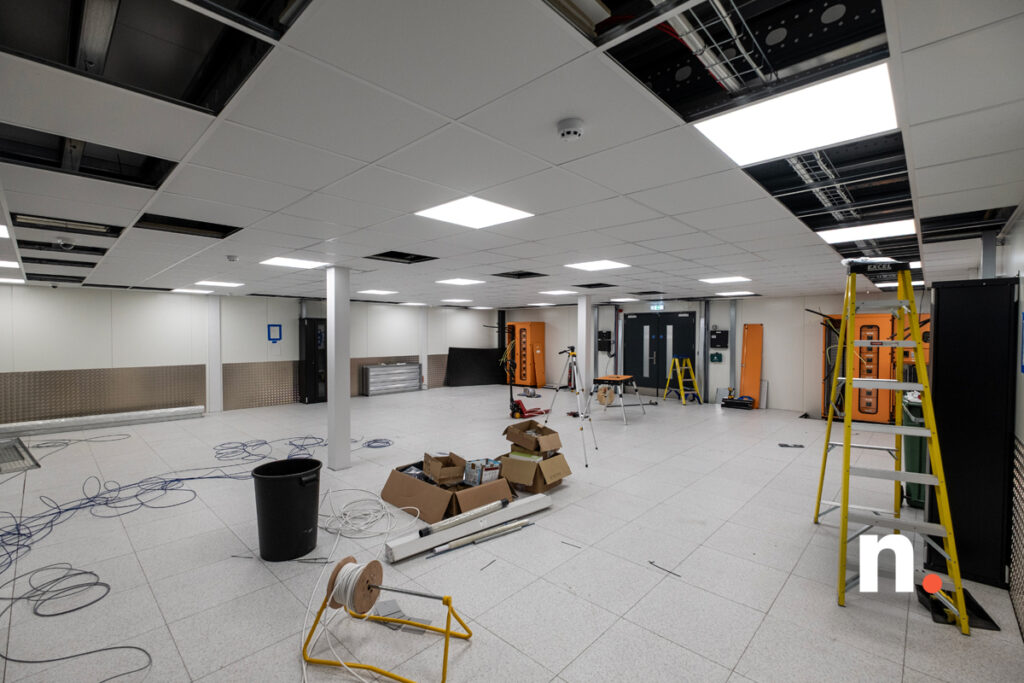

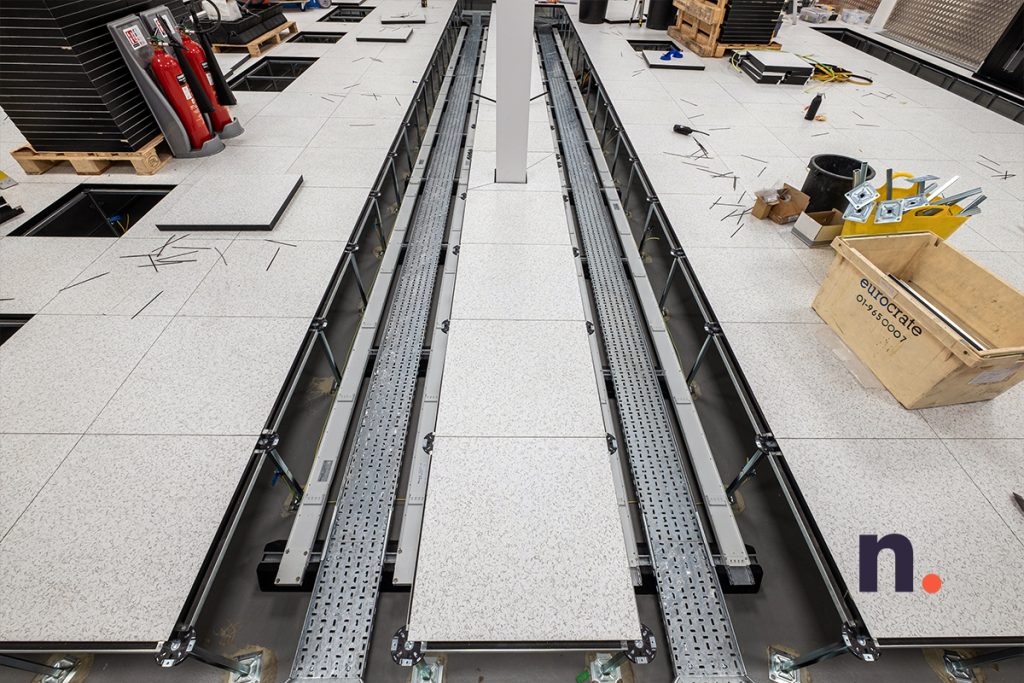

Some of the custom (and rather intricate!) multi-level containment work can be seen underfloor here, designed and installed by our expert in-house electrical team
DH3
All containment is handled ahead of flood cabling and termination, which is set to begin very soon
DH3
There are fully diverse containment routes flowing around the entirety of each data hall sub-floor, to ensure the maximum level of compliant power delivery to each client rack
DH3
Data Hall 3 has a matching power delivery system to that found in Data Hall 4, which came online in the summer of 2024 – this was an evolution of the power delivery system design deployed in the first floor Data Halls (1 and 2)
DH3
A view across Data Hall 3, as work on the under floor infrastructure continues
DH3
Terminations within the main distribution boards 3 are well underway here
DH3
Here we see the supplementary CRACs under commissioning within Data Hall 3, after positioning on their custom plinths
DH3
As part of the CREC system installation for Data Hall 3, modifications are being made within the cold corridor in Data Hall 1, as part of the hot air extraction system
DH3
These modifications will ultimately result in a matching setup as seen previously in this post, which now functions across the Data Hall 2 / Data Hall 4 extraction pairing
DH3
Additional intake filters will also be added to the Data Hall 1 cold corridor soon, as part of the Phase 2 finalisation works
DH3
On the topic of filters, here we see the cold corridor within Data Hall 2, as a full filter change is undertaken – this includes main intake filters (seen here), along with all internal cooler filters, wet pads, and the final cold air exit filters, all of which are contained within the CREC wall
DH3
The CRECs and associated filters have arrived, ready for installation within Data Hall 3

This has been quite a significant update post, given that it covers Phase 2 works spanning back to mid-2024. This phase will see the completion of all deployable data hall space within the active side of Netwise London East, which will reach completion ahead of the active Phase 3 works.

We’re now in the closing stages of Phase 2; Data Hall 3 will be onlined and ready to receive incoming customer deployments in the next few months. We’ll be providing final Phase 2 build blog updates as this work reaches completion.

Phase 3 will continue alongside these final Phase 2 works, however internal focus is now firmly on getting Data Hall 3 ready for occupation.

London East Phase 3 Development Update 4

As we enter Q2 2025, development works continue at Netwise London East, with many additions to relay in this latest edition of our build blog.

Some internal engineering focus has now shifted back to the closing stages of Phase 2, with the roll-out of the final data hall within the active side of the facility (more on this very soon), however the completion of the initial envelope works schedule – as part of the Phase 3 expansion – is still pressing towards finalisation.

Here are the latest updates:

Envelope
A bulkhead has now been installed along the front of the new mezzanine, to close off the otherwise open edge between the ground and first floor wall systems
Envelope
The new bulkhead not only creates a more pleasing finish, but also adds further fire and bash protection to this surface – this will be further bolstered in the loading dock areas to allow for easier forklift access for heavy goods and plant / materials
Forklift
On the topic of forklifts, we’ve added a second to our fleet, with another Linde unit capable of heavier lifts and greater reach
Envelope
The warehouse and loading bay in the facility expansion has far more pallet racking, which is also taller than that within the current loading bay area
Racking
The pallet racking has since been built out further, with additional bays and rear overspill protection – we have a custom infill section coming soon, to sit in the gap presently seen on the left hand side here
Breach
There have been additional breaches made to existing block walls, as we create a new route between the NOC / office space and the technical spaces within this area on the first floor
Breach
The new route creates an open pathway for staff working in this side of the facility – doors, glazing and access ramps will be added later to finish this route
Breach
Here is the view from the new front NOC / office within the expansion space, with larger, free-flowing double doors to be installed in place of the previously existing single doorway, which will be infilled with a new glass panel
Breach
This is the view through from the NOC / office in the front of the building, looking through to the new office and meeting spaces on the first floor
Envelope
Here we see the newly mounted loading dock doors for the ground and first floors
Envelope
The checker plate wall protection has been installed to match that within the active side of the facility
Envelope
The cable route breaches have been cut and lined, ready for cabling and eventual fire protection later in the project – these are the B-side power and supplementary AC routes for Data Hall 6
Envelope
The checker plate on the ground floor continues through to the rear corridor, which connects through to the new power servicing area
Envelope
The adjacent corridor leading to the power servicing area, seen here clad with its checker plating
Envelope
The checker plate throughout the facility has been installed to a datum line set based on the raised floor installation (as have the doors), which will come later in the project
Envelope
The view across Data Hall 6, which is being used for equipment and material storage at present, showing the flanking checker plate cladding now in place
Envelope
The four individual rooms that make up the new power servicing area have custom access panels installed to allow for access behind the rear wall system – these are both fire and high security panels
Envelope
Here is a view of the new main entry door installed in Data Hall 5
Envelope
The same view inside of Data Hall 5, following the checker plate installation on the flanking walls
Envelope
The checker plate is from a continuous production run, meaning we have secured a pattern-match between individual panels
Envelope
This is one of what will become a twin door access route through to the cold corridor in Data Hall 5 (which is why this has been set back slightly) – this will be a fire exit route, as well as a general ease-of-flow route on the first floor, which will also be a soundproofed barrier with twin doors and drop seals
Envelope
This is the view of the first floor corridor, as final trims are prepared, and ahead of checker plate installation – the new cable route breaches have been made here, ahead of lining
Envelope
This is the view to the first floor breach point between the extension project and the active side of the facility, which has now been blocked off with the new wall system, ahead of the final interlink doorway being cut and fitted in due course
Fencing
Here we see the completed side run of new security fencing, ahead of the final razor wire fitment
Fencing
A view of the same side run, looking towards the front of the facility
Fencing
The rear run connects in with our existing run along this side of the facility
Fencing
The razor wire will be installed next, along with the full front facing run of fencing, which will include an additional turnstile and automated vehicle gate
CCTV
Our secure perimeter mixes a range of systems and technologies to create an extremely robust protected boundary around our facilities
CCTV
The new external PTZ cameras that give an overview of the perimeter are now installed and live on our integrated security system, already giving our team full perimeter visibility and motion tracking at this early stage of the project

The forthcoming works schedule includes completion of the perimeter fencing (including the new turnstile and automated vehicle gate), the cutting and fitment of the final interlink doorways, the installation of early stage cable containment across the entirety of the new space, the installation of the new water feed system(s) for our primary evaporative cooling architecture, and a host of additional preparatory work as we wrap up the first stage of the envelope installation.

We’re also taking delivery of the new UPSs, cooling systems, and switchgear, as we look ahead to the largest aspect of the project, that being the commissioning of the main service utilities.
